Yes, you need one. In Los Angeles, garage conversion permits typically took 144 days to issue, and a quarter of them took more than nine months. That is not a city estimate. It comes from 15,682 applications the city itself publishes, submitted between 2021 and 2024, counted from the day the paperwork went in to the day the permit came out.
The gap between what cities promise and what their own records show is the subject of this article. California law puts a 60-day clock on an ADU decision. Across those 15,682 Los Angeles applications, 22 percent were issued within 60 days of the application going in.
We built a permit timeline calculator so you can run your own city and project against 50,655 public records from Los Angeles, San Diego, San Francisco and Seattle. This article explains what the numbers mean and what to do about them.
Do you need a garage conversion permit in California?
Yes, without exception, if the garage is becoming living space. Converting a garage changes the occupancy classification of the structure, and that alone triggers a building permit in every California jurisdiction. Adding a bathroom pulls in plumbing. Adding outlets and lighting pulls in electrical. Heating or cooling pulls in mechanical.
Most cities issue these as one combination permit rather than four. Los Angeles calls it a Building Alteration or Repair permit, and roughly half the city's garage conversion permits are filed that way.
There is a second question underneath the first, and it decides everything else: are you creating an accessory dwelling unit, or a room?
A room in a garage is a bedroom, an office or a gym, and it shares the main house's kitchen. An ADU is a complete independent living unit, which under California Government Code 66313 means permanent provisions for living, sleeping, eating, cooking and sanitation. All five. Remove cooking and it stops being an ADU.
That changes which state protections apply, which deadlines bind the city, and whether it can charge you impact fees. The last section covers the threshold, and it is worth reading before you draw plans.
A correction worth making, because the page currently ranking first for this search gets it wrong. It states that replacement parking is not required "if the property is within half a mile of public transit." There is no transit condition. Government Code 66314(d)(11) says that when a garage, carport, covered parking structure or uncovered parking space is demolished or converted to an ADU, the local agency "shall not require that those offstreet parking spaces be replaced." No transit condition, no size condition, anywhere in the state.
The half-mile rule is a different provision, 66322(a)(1), and it governs whether the ADU must provide parking for itself. Two separate rules, and conflating them is how homeowners end up surrendering a parking space they never had to give up.
One caveat that cuts the other way: this protection applies to ADUs. Convert the garage into a plain habitable room and the state offers you nothing on parking. Local zoning governs, and cities do require replacement. San Diego's published Information Bulletin 142 states it plainly: where an existing garage is proposed for conversion to habitable area, garage parking must be replaced with an equivalent number of spaces on the premises.
How long do garage conversion permits actually take?
In Los Angeles, half of the permits were issued within 144 days. A quarter took more than 272 days. One in ten took more than 483.
Here is the spread across those 15,682 applications:
| Days from application submitted to permit issued | |
|---|---|
| Fastest 25% | 69 |
| Typical (median) | 144 |
| Slowest 25% took more than | 272 |
| Slowest 10% took more than | 483 |
City records, applications submitted 2021 to 2024, analysed by Renology.
Four cities, same method, different years:
| City | Applications from | Typical wait | Issued under 60 days | Permits |
|---|---|---|---|---|
| San Francisco | 2022 to 2025 | 69 days | 47% | 541 |
| Seattle | 2022 to 2025 | 112 days | 23% | 421 |
| Los Angeles | 2021 to 2024 | 144 days | 22% | 15,682 |
| San Diego | 2018 to 2021 | 185 days | 15% | 3,197 |
Three things about this table need saying before anyone quotes it.
This is not a league table. Each city is measured on its own most recent settled years, and those windows do not overlap cleanly. San Diego's window predates the pandemic backlog that the other three sit inside. Reading these four rows as a ranking of city performance today is exactly the thing the table cannot support. Compare a city to itself over time, not to the city below it.
Seattle is a benchmark, not a deadline. California's 60-day rule is California law. The Seattle row uses 60 days as a common yardstick so the columns line up, and no Washington statute is implied.
The clock measures the city, not the project. It starts when the application is submitted and stops when the permit is issued. It excludes design, plan preparation, any planning review before you file, and every day of construction. If you are budgeting a project timeline, this is one segment of it.
The 60-day clock, and why our number is not a compliance rate
California Government Code 66317(a)(3) gives a local agency 60 calendar days to approve or deny an ADU application. Miss it and the application is deemed approved.
Read the section carefully, because two details change what can honestly be measured. The 60 days run from the date the agency receives a completed application, not the date you file. And the statute says that if the applicant requests a delay, the 60-day period is tolled for the length of that delay. Since 2026 the agency also has 15 business days to tell you whether your application is complete, and that notice is where the clock actually starts.
Permit records carry the submission date. They do not carry the completeness date and they do not carry tolling. So the figure below starts earlier than the statutory clock and never pauses, which makes it a measure of the wait you will actually experience and not a measure of whether the city broke the law. Anyone presenting it as a compliance rate, including us in an earlier version of this page, is overstating it.
That distinction is worth holding onto, because the longer clock is the one that governs your calendar.
Share issued within 60 days of applying, Los Angeles, by the year the application was submitted:
| Applications from | Issued within 60 days |
|---|---|
| 2021 | 14% |
| 2022 | 21% |
| 2023 | 25% |
| 2024 | 28% |
The direction is genuinely good. The rate doubled in three years. It is also still the case that seven applications in ten take longer than two months to produce a permit, in a city processing roughly 4,000 garage conversion applications a year.
The deemed-approved remedy exists on paper. Invoking it means telling your building department that its own delay approved your project, then asking that same department for six months of inspections. Homeowners rarely use it. Knowing it exists is still worth something in front of a plan checker.
[[CTA-1 mid-article]]
Why does one permit take three months and another takes a year?
The strongest predictor in the records is not the project. It is the review track.
Los Angeles routes permits down three lanes, and which lane a project lands in moves the timeline more than anything a homeowner controls:

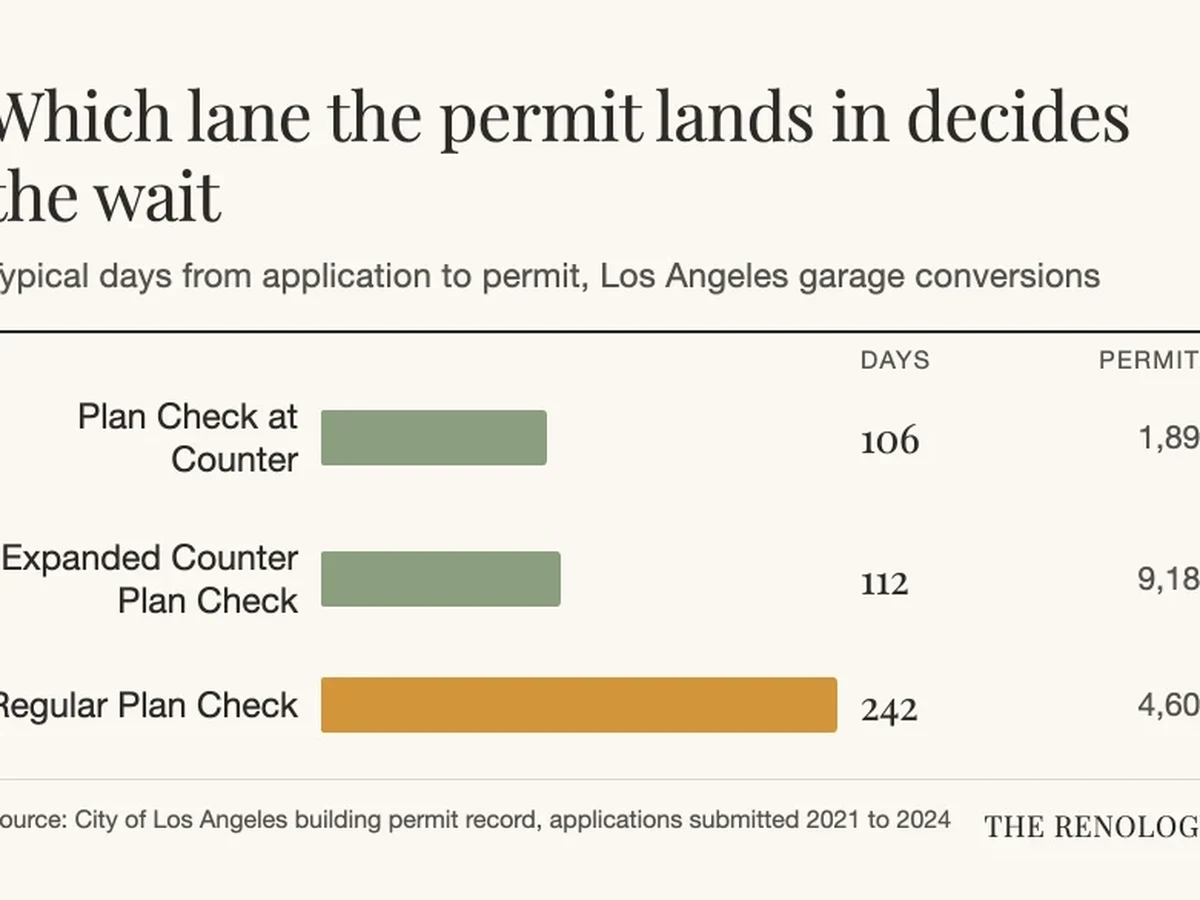

| Review track | Typical wait | Slowest 25% | Issued under 60 days | Permits |
|---|---|---|---|---|
| Plan Check at Counter | 106 days | 218+ | 32% | 1,898 |
| Expanded Counter Plan Check | 112 days | 206+ | 29% | 9,180 |
| Regular Plan Check | 242 days | 413+ | 3% | 4,603 |
Same city, same period. A permit in Regular Plan Check takes more than four months longer at the median, and 3 percent of them clear in under two months against 32 percent at the counter.
The track does not cause that on its own. Complex projects are routed to the slow lane precisely because they are complex, so part of the gap is the projects and not the queue. What matters for planning is that the routing is knowable in advance and the wait attached to it is this large.
This is the single most useful thing on this page. Before you sign anything, ask your designer or contractor which track the submittal is going into. If the answer is Regular Plan Check, your planning horizon is eight months, not three, and every decision about tenants, financing or move-out dates should assume it.
What pushes a project into the slower lane is complexity that a counter reviewer cannot resolve in a single sitting: structural changes to the roof or foundation, work in a hillside or coastal zone, anything touching a fire-rated wall, and any deviation that needs a second department to weigh in.
The finding that surprised us
The state gives ADUs a 60-day clock, a parking protection and a fee exemption. A plain habitable room gets none of that.
And the ADU permit is slower.
| Project | Typical wait | Issued under 60 days | Permits |
|---|---|---|---|
| Garage to ADU or JADU | 145 days | 22% | 14,862 |
| Garage to a habitable room | 133 days | 25% | 820 |
Twelve days is not a dramatic gap, and the room sample is small enough to read as a rough comparison. But the direction is the point. Legal protection did not translate into a faster permit. An ADU brings more drawings, more review disciplines and more scrutiny, and that appears to consume whatever the clock was meant to buy.
What does the permit cost, and what is the fee calculated from?
3 ADU builders, editor-screened. 4 questions.
See my 3 matchesPermit fees are calculated from your declared valuation, which is the construction value you state on the application. That figure sets the plan check fee and the permit fee, and it is why two identical garages can carry different permit costs.
There are three separate buckets, and homeowners routinely budget for the first while being surprised by the second:
Plan check and permit fees. Charged by the building department and scaled to your declared valuation, which is why two identical garages can carry different permit costs. Each city publishes its own fee schedule, and it is the one number here you can look up before you apply.
Impact fees. Charged for the load a new dwelling unit puts on schools, parks, sewer and water. These are the large ones, and they are also where state law gives you the most protection. Government Code 66311.5(c)(1) bars any impact fee on an ADU of 750 square feet or less of interior livable space, or a JADU of 500 square feet or less. Above 750 square feet the fee is charged proportionally to the size of the main house. Most garage conversions land under the threshold, which is not a coincidence.
Read that exemption narrowly. It covers impact fees. Connection fees and capacity charges sit in different subdivisions of the same section and are not swept in by it, a distinction some contractors flatten when they quote you.
School and utility connection charges. Assessed separately, and often smaller than expected for a garage already on the property's existing service.
We do not publish a single dollar figure here because the records carry declared valuation, not what anyone paid, and declared valuation is self-reported and systematically low. It is a floor, not a price. Our garage conversion cost guide works through the full project number, permits included, with the same records and the same caveat stated plainly.
What happens if the garage was already converted without a permit?
This is the most common version of this question, and California law changed in your favour recently enough that most of what you will read online is out of date.
Assembly Bill 2533, effective January 1, 2025, requires a local agency to allow permitting of an unpermitted ADU or JADU built before January 1, 2020. The city may not deny the permit for failing to comply with building standards, and may not deny it for failing to comply with the local ADU ordinance. It may not charge penalties, and it may not charge impact fees or connection and capacity charges, with one narrow exception for utility infrastructure genuinely needed to meet Health and Safety Code 17920.3.
Note the code section carefully. That law now lives at Government Code 66311.7. It was renumbered by Senate Bill 543 effective January 1, 2026, from its old home at 66332. Nearly every article on this subject, including guidance published in early 2025, still prints the old number. If you are citing it to a plan checker, cite the current one.
The city retains exactly one basis to refuse: where correction is necessary to address a substandard condition under Health and Safety Code 17920.3, or where the structure is already deemed substandard. That is a safety exit, not a compliance exit.
Two limits. The cutoff is construction before January 1, 2020, and a unit built after does not qualify. And state law does not require a branded "amnesty program," only the pathway and a published checklist of substandard conditions, so do not go looking for a program that may not exist by that name.
There is also an unresolved question that any honest article should flag rather than paper over. Health and Safety Code 17980.12 lets an owner request a five-year delay of code enforcement, after which the city can require full compliance. How that interacts with 66311.7, which bars denial over code noncompliance, is not settled. Regional guidance published in March 2026 states directly that there is no case law on the interaction. Two readings are defensible, and anyone telling you otherwise is guessing.
And if you are selling
In California, an unpermitted conversion is not a judgment call at sale time. The state's Real Estate Transfer Disclosure Statement, required by Civil Code section 1102 for most one-to-four unit homes, has a specific line for alterations made without necessary permits. That duty cannot be waived, and selling "as is" does not remove it.
When does a garage conversion become an ADU under state law?
Cooking is the trigger.
Government Code 66313 defines an ADU as a unit with permanent provisions for living, sleeping, eating, cooking and sanitation. A converted garage with a bedroom, a bathroom and a sitting area is a habitable room. Add a kitchen and it becomes a dwelling unit, and a different body of law attaches to it.
A junior ADU is the smaller cousin: up to 500 square feet, within the walls of the existing home, and needing only an efficiency kitchen, which Government Code 66333(f) describes as a cooking facility with appliances plus a food preparation counter and storage cabinets of reasonable size. An attached garage counts as within those walls, which is why attached-garage JADUs are common.
What changes the moment it becomes an ADU:
- The 60-day ministerial clock under 66317 applies
- Replacement parking cannot be required, under 66314(d)(11)
- Setback waivers for conversions apply under 66314(d)(7)
- Impact fees are waived under 750 square feet, under 66311.5
- The pre-2020 amnesty at 66311.7 becomes available
A bedroom conversion gets none of these. It is also, per the measured data above, marginally faster to permit. Which of those two facts matters more depends entirely on whether you intend to rent the space.
One more piece of 2026 context. The 2025 legislative session produced four ADU bills that took effect January 1, 2026: SB 543 did the renumbering and added the 15-business-day completeness rule, AB 1154 changed JADU owner-occupancy so it applies only where a bathroom is shared, SB 9 voids a local ADU ordinance not submitted to the state within 60 days, and AB 462 brought coastal development permits onto the 60-day clock. The current state reference is the HCD ADU Handbook, March 2026 edition. Anything citing the January 2025 edition is a cycle behind.
The Renology Take
The instinct after a table like this is to treat 60 days as the standard and everything above it as failure. That framing is comfortable and wrong.
Look again at San Diego. Its numbers stop at 2021, and not because the city stopped publishing. Only 67 percent of its 2024 applications have any decision. A city can look fast by issuing the easy permits and letting the hard ones sit, and a median built on whatever finished would flatter it for years.
So the figure that deserves your attention is not the median. It is the 4,471 Los Angeles applications of 23,735 filed between 2020 and 2024, 19 percent, with no permit on the day we pulled the records. Some are in review, some abandoned. The data cannot say which, and none carry a denial.
A slow permit is a scheduling problem. An application that produced nothing in four years is a different risk, and nobody measures it.
How we measured this
The figures on this page come from the public permit records of four cities: Los Angeles (LADBS), San Diego (DSD), San Francisco (DBI) and Seattle (SDCI).
50,655 records passed the filter across all years. The tables above use a smaller subset, 19,841 permits, because each city reports only its most recent settled cohorts. The rest of the records are real but sit in years too recent or too old to compare, and they are excluded rather than quietly averaged in.
Records are deduplicated on the permit number, revisions and supplementals are dropped, and a permit counts only where the garage is becoming living space rather than storage or laundry. Applications are grouped by the year they were submitted, never the year the permit was issued, because grouping by issue date mixes in old backlog and oversamples slow permits. Any combination with fewer than 30 records is not published. A year is only reported once at least 75 percent of its applications have an outcome, which is why the most recent years are absent from every city.
The records carry no denied, withdrawn or expired status, so an application with no issue date may be a stalled review or an abandoned project. They do not distinguish the two.
They also carry no completeness date and no record of tolling, which is why every 60-day figure on this page is described as issued within 60 days of applying rather than as compliance with Government Code 66317. Nothing here predicts an individual permit, and nothing here is legal advice.
The full dataset, with the filter and the extraction date, is at the permit timeline calculator.
Methodology
How Renology builds this guide
Renology combines public permit and labor signals, supplier pricing, remodeler quote patterns, and editorial review of comparable projects. Cost references are planning ranges, not fixed bids, because site conditions, materials, access, permits, and finish level can change the final price.
- Benchmarked against the Renology Cost Index, related service guides, and the Renology Methodology.
- Reviewed for local market context when a local market is available.
- Focused on ADU scope, materials, timeline, contractor risk, and budget drivers.
Frequently Asked Questions
How long does a garage conversion permit take in California?
Is the 60-day state deadline real, and did the city meet it?
Do I need to replace the parking space I am losing?
Can I get a permit for a garage that was already converted?
What makes it an ADU instead of a room?
Get 3 ADU bids in 48 hours.
Our editors already vetted ADU builders. Answer 4 questions and we send 3 written bids inside 48 hours, with the real price for your scope, not their inflated first-call number.
- Free, no commission
- Pre-screened locally
- Bids inside 48 hours
Takes about 60 seconds. We'll text you when bids arrive.
Sources
- California Government Code 66310 to 66342, accessory dwelling units
- California Department of Housing and Community Development, ADU Handbook, March 2026
- City of Los Angeles building permits, issued, public dataset
- City of Los Angeles building permits, submitted, public dataset
- City of San Diego development permits, public dataset
- City of San Diego Information Bulletin 142, parking regulations
- California Civil Code 1102, transfer disclosure statement
