California Garage Conversion Costs: Building a Complete Budget

In this article

A California garage-conversion budget needs a defined scope and current proposals. Permit valuations can show how projects were recorded, but they are not paid invoices and cannot be converted into your all-in price by adding a standard percentage. Start with the existing structure, the intended use and the work excluded from each quote.

How should you budget for a garage conversion in 2026?

Build the budget from priced work, not a permit multiplier
Budget lineWhat to establish
Existing structureAssessment and specified repairs to slab, foundation, framing, roof and moisture conditions.
Conversion scopeRoom within the home or independent ADU, with the intended facilities and use.
Design and approvalsDrawings, engineering, application services and official fees identified separately.
Systems and connectionsPlumbing, electrical, ventilation and heating scope, plus any external connection work.
Finishes and owner purchasesExact inclusions, allowances and delivery or installation exclusions.
Unresolved conditionsInvestigation needed, responsibility and a process for pricing changes.

Ask for the same scope from each contractor. If one bid covers the building and another includes design, utility coordination and landscaping repairs, their totals are not directly comparable. Our living-space versus ADU guide helps define the intended use before requesting prices.

What the earlier permit analysis reported

Historical extraction, not a current quote benchmark. The three tables preserve the figures previously published from the Los Angeles permit dataset and San Francisco permit dataset. They have not been recalculated for this September content revision. Counts describe records in the earlier extraction, not independently verified completed homes. The San Francisco 2026 row is a subset; the neighborhood table uses the broader earlier extract.

MetroPermits25th percentileMedian75th percentile
Los Angeles, garage to ADU9,898$20,000$30,000$50,000
Los Angeles, garage to habitable space7,013$22,000$35,000$57,000
San Francisco, garage to ADU, 202638$121,997$189,598$268,000

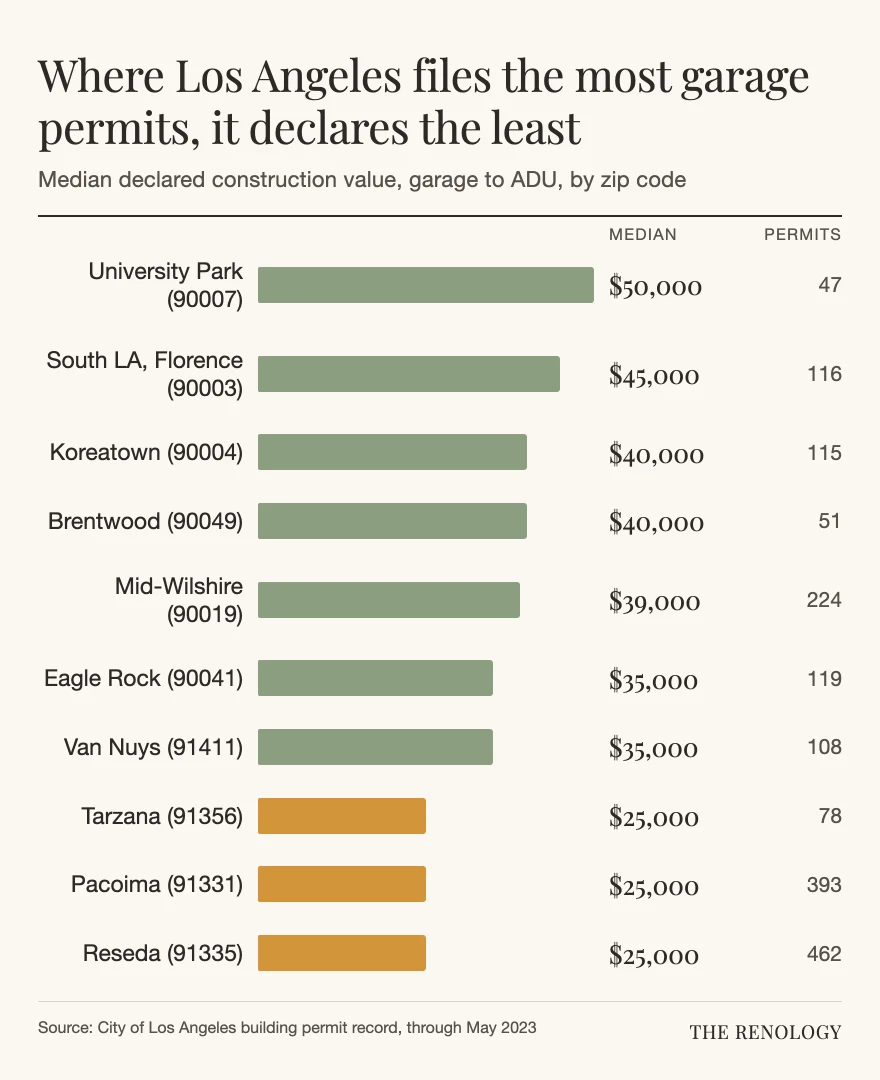

ZipCommon namePermitsMedian declared
90007University Park47$50,000
90003South LA, Florence116$45,000
90004Koreatown, Larchmont115$40,000
90049Brentwood51$40,000
90019Mid-Wilshire224$39,000
90041Eagle Rock119$35,000
91411Van Nuys108$35,000
91335Reseda462$25,000
91331Pacoima393$25,000
91356Tarzana78$25,000
NeighborhoodPermitsMedian declared
Marina15$265,000
Castro, Upper Market14$262,000
Mission33$210,000
Haight Ashbury21$200,000
Noe Valley13$170,000
Inner Richmond28$125,000
Outer Richmond26$122,500
Sunset, Parkside34$120,000
Bernal Heights9$100,000

The tables mix project descriptions, locations and observation periods. They cannot establish that an ADU is cheaper than a room conversion, that a detached conversion is always cheaper than an attached one, or that one city’s construction costs are a fixed multiple of another’s. Small neighborhood cohorts and permits containing wider work require particular caution.

Why can a contractor quote differ from the permit valuation?

A valuation is an administrative measure associated with a permit. It may not use the same scope, date or accounting basis as the proposal in front of you. It is not a guaranteed lower bound, and a low recorded value does not establish that a higher quote is inflated. Ask what each number includes before comparing them.

An earlier version recommended adding 25–40% to a local permit median. That is not a validated conversion from permit value to completed-project cost, and we have withdrawn it. Design, fees and utility costs should be priced for the actual project rather than added through that shortcut.

A worked comparison of two conversion proposals

Illustrative figures only: Proposal A is $100,000 but excludes $8,000 of design work and $12,000 of identified connection work. Proposal B is $116,000 and includes those same items. If the remaining scope is identical, A totals $120,000 and B remains $116,000. Neither total includes a still-unresolved foundation repair. These invented inputs demonstrate reconciliation; they are not California market estimates.

Write “unresolved” beside any item that still needs investigation. Do not count an allowance again as a separate extra if the same amount is already included in the contract. Keep optional upgrades separate from money reserved for unknown conditions.

Which fees and approval costs apply?

Ask the local authority and serving agencies for the applicable fees and any exemptions under the selected project route. The HCD ADU Handbook addresses distinctions that make blanket fee percentages unreliable. A room conversion and a qualifying ADU should not automatically receive the same assumptions.

For timing, use the garage-conversion permit analysis and a current schedule from the project team. A permit dataset does not establish how many weeks your construction, utility work or final inspections will take.

Is the conversion worth doing?

Compare the complete, priced investment with the use you need from the space. For rental plans, model vacancy, operating expenses, financing and other ownership costs using your own assumptions and appropriate professional advice. A declared permit median is not enough to predict payback, rent or resale value.

What to ask before accepting the quote

Ask the contractor to identify the existing-condition assumptions, the included drawings and approvals, each allowance, and all owner-paid work. Have the team explain how a newly discovered repair will be documented and approved. Check the contracting business through CSLB’s license lookup before signing.

Which fees can state law remove from a garage-to-ADU budget?

Size is the first fee decision. Under Government Code Section 66311.5, a local agency, special district or water corporation cannot charge any impact fee on an ADU with 750 square feet or less of interior livable space, or on a junior ADU of 500 square feet or less. Above 750 square feet, impact fees are allowed, but they must be charged in proportion to the square footage of the main house.

Two things stay in the budget at any size. First, the same section says an impact fee does not include connection fees or capacity charges from a water or sewer provider; those follow their own rules, covered below. Second, the definition of a development fee in Government Code Section 66000 excludes fees for processing applications for regulatory approvals, so plan check and permit processing charges are a separate line from impact fees.

Los Angeles shows how the rule lands locally. The city's ADU information bulletin P/BC 2026-150 names the Residential Development Fee and the Dwelling Unit Construction Tax as the impact fees charged proportionately on larger units. The same bulletin states that ADUs and junior ADUs are exempt from park fees and from the Affordable Housing Linkage Fee.

How the main fee types treat a garage converted to an ADU
ChargeWhat state law saysSource
Impact feesNone on an ADU of 750 square feet or less; proportional to the main house above thatGov. Code 66311.5(c)
School district feeAllowed on other residential construction only when assessable space grows by more than 500 square feetEd. Code 17620(a)(1)(C)
Water and sewer connectionNo new or separate connection, and no related fee, for a qualifying unit inside existing spaceGov. Code 66311.5(d)
Application processingNot counted as a development fee under the state definitionGov. Code 66000(b)

When does the school district fee apply?

School fees come from a separate agency: the school district, not the building department, levies and certifies them. Education Code Section 17620 lets a district charge other residential construction only if the resulting increase in assessable space exceeds 500 square feet, and when it applies, the fee covers the total increase. Government Code 66311.5 adds that an ADU or junior ADU with less than 500 square feet of interior livable space is treated as falling under that 500 square foot line.

The definition matters for a garage. Government Code Section 65995 defines assessable space as the square footage inside the perimeter of a residential structure, not including any garage, carport, patio or detached accessory structure. Because garage area is left out of that count, ask the district how it will measure your converted space before the floor plan is final. A design that lands just over 500 square feet can change the answer.

The fee cannot be skipped by accident. Section 17620 says a city or county shall not issue a building permit without certification from the school district that the fee was paid or that it does not apply; in some districts the check moves to the final inspection or certificate of occupancy instead. Budget a step to obtain that certification, even when the expected fee is zero.

The per square foot ceiling moves every two years. In January 2026 the State Allocation Board raised the maximum Level I assessment by 4.06 percent, based on a construction cost index. Higher Level II and Level III fees exist for districts that meet extra state requirements, so the district's own fee schedule is the number to use. In Los Angeles, the city bulletin states that LAUSD school fees are required for ADUs larger than 500 square feet.

Will the water and sewer provider charge a connection fee?

It depends on whether the unit stays inside the existing structure. Government Code Section 66323 requires ministerial approval of one ADU per single-family lot when the unit is within the existing space of the house or an accessory structure, such as a garage, with any expansion limited to 150 square feet and only to accommodate ingress and egress.

For a unit that fits that description, Section 66311.5(d) says the local agency, special district or water corporation shall not require a new or separate utility connection between the unit and the utility, or charge a related connection fee or capacity charge. The exceptions are a unit built together with a new single-family house and a unit later sold separately under the state's separate conveyance rules.

For other ADUs, such as a conversion that grows past that 150 square foot allowance, Section 66311.5(e) allows the provider to require a separate connection. Any connection fee or capacity charge must then be proportionate to the unit's burden on the system, based on its square feet or its drainage fixture unit values, and cannot exceed the reasonable cost of the service.

Los Angeles adds detail on the plumbing side. Its bulletin states that detached ADUs are not required to have independent drainage connections if the existing service complies with the current plumbing code, and that the ADU must have a separate water shut-off valve accessible in the unit. The Bureau of Engineering must approve every ADU for sewer capacity and availability before the permit is issued.

Which code requirements turn into budget lines?

A garage was built to park cars, so a conversion has to bring an unconditioned shell up to dwelling standards. The table lists the common line items as requirements, not prices. The detailed standards come from the Los Angeles bulletin for converting an existing building to an ADU; other cities adopt the same state codes with their own local amendments, so check the bulletin or checklist your building department publishes. The parking, sprinkler and setback rows are state law under Government Code Section 66314 and apply statewide.

Garage conversion line items and the requirement behind each
Line itemWhat the requirement saysSource
Slab and moistureExisting slabs may stay with an approved sealant as a moisture barrier; a new slab needs reinforcing and a moisture barrier membraneLADBS P/BC 2026-150
Footings and the old door openingExterior and bearing walls must sit on continuous footings; the infill wall at the garage door opening is framed at 16 inches on centerLADBS P/BC 2026-150
Insulation and energyAll new conversion work must meet Title 24, Part 6, documented on a CF1R certificate attached to the plansLADBS P/BC 2026-150
Egress windowsEvery sleeping room needs an emergency escape opening of at least 20 inches wide, 24 inches high and 5.7 square feetLADBS P/BC 2026-150
Electrical panelThe ADU requires a separate electrical panelLADBS P/BC 2026-150
HeatingHeat must hold 68 degrees Fahrenheit; portable space heaters do not countLADBS P/BC 2026-150
Fire-rated wallsWalls under 5 feet from a property line on a non-sprinklered conversion must be 1-hour ratedLADBS P/BC 2026-150
Parking replacementA garage converted to an ADU does not have to have its parking replacedGov. Code 66314(d)(11)
Fire sprinklersNot required in the ADU if the main house does not require themGov. Code 66314(d)(12)
SetbacksNo setback can be required for an existing structure converted to an ADUGov. Code 66314(d)(7)

Three of these lines can lower the budget rather than raise it. No replacement parking means no new carport or paved space is forced by the conversion. No sprinkler mandate, when the main house has none, keeps a sprinkler system out of the scope. And no setback requirement for the existing structure means a garage close to the lot line can usually be kept in place, though the fire-rated wall row may then apply.

Several rows depend on conditions that stay hidden until someone looks: the condition of the slab, whether footings exist under the old door opening, and how much capacity the existing electrical service has for a separate panel. These are the items to have the contractor inspect and price before signing, rather than carry as open allowances. For the permit steps themselves, see the garage-conversion permit guide.

What costs sit outside the construction contract?

Some money is spent on approvals rather than building, and a construction bid often leaves it out. The Los Angeles bulletin lists the main ones:

  • Records research. If the garage was permitted before, copies of its Certificate of Occupancy and earlier building permits must be provided at plan check.
  • Clearances from other departments. LADWP approval if the structure sits in or within 10 feet of a public utility easement; Bureau of Engineering clearances for sewer availability, roof drainage where the drainage pattern changes, and an address; Fire Department approval for hydrants and access; and a City Planning clearance where it applies.
  • Exposing hidden work. The inspector may require existing covered or concealed work to be opened for examination. Opening and patching walls is real labor that belongs in the contingency.

Clearances must be approved before the permit and the Certificate of Occupancy are issued, according to the bulletin. Ask who on the project team handles each one and whether that time is in the design fee or billed separately. To size the reserve for items like these, see what a 10 to 15 percent contingency actually pays for.

Does legalizing an existing garage unit cost less in fees?

It can. California's AB 2533, codified at Government Code 66311.7, limits denials of permits for unpermitted ADUs built before January 1, 2020. The Los Angeles bulletin states that owners permitting such a unit are not required to pay impact fees, connection fees or capacity charges, unless utility infrastructure improvements are needed to meet the health and safety standards in Health and Safety Code Section 17920.3.

The bulletin also notes that these older units are not required to comply with the California Energy Code. The owner may arrange a third-party inspection by a licensed contractor to check the unit against the city's substandard checklist, and that inspection does not replace the city's permit and inspections. Proof of the construction date, such as utility bills, a lease or contractor receipts, is part of the application.

How does the conversion affect property tax?

Expect the annual tax bill to rise, but only on the new work. Under Revenue and Taxation Code Section 71, the assessor sets a new base year value for the portion of the property that was newly constructed, and the base year value of the rest of the property does not change. Ask the county assessor how it will value the converted space, and add the difference to the yearly carrying cost of the unit.

Why national remodeling reports do not price a garage conversion

The 2025 Cost vs. Value Report compares average costs for 28 remodeling projects in 119 U.S. markets, and none of them is a garage conversion. Its closest line, "Accessory Dwelling Unit," shows a national average job cost of $166,406 and a resale value of $68,656. The project description is a new 660 square foot, one-story building on a structural slab, including a paved parking area. A conversion reuses an existing slab, walls and roof, so that figure is not a garage conversion benchmark, high or low. The report's ADU line is useful only as a reminder that resale value and construction cost are different questions.

A budget order that avoids surprises

  1. Decide the route first: a room for the house or an ADU. The impact fee and connection fee rules above are written for ADUs and junior ADUs, while the school fee rule covers other residential construction too.
  2. Fix the size. Interior livable space of 750 square feet or less removes ADU impact fees; staying within the garage footprint, plus at most 150 square feet for entry, keeps the no-separate-connection rule in play.
  3. Call the school district and the water and sewer providers for written fee determinations on the planned square footage.
  4. Have the slab, footings at the old door and the electrical service inspected before pricing.
  5. Get the local fee schedule for plan check and permits, and list clearances by department.
  6. Request bids on the same scope, with allowances and exclusions written out, and compare them against local data on the Renology cost index.
  7. Add a contingency for concealed conditions and the property tax change to the yearly carrying cost.

For Los Angeles projects, the Los Angeles garage ADU page covers local options.

Sources and Methodology

Reviewed September 28, 2026. The content and interpretation were reviewed; the retained historical permit tables were not recomputed. Earlier fixed markups, payback claims and construction-duration predictions were removed. A future data refresh needs reproducible selection criteria and a new extraction, not a changed date on the old tables. See our editorial methodology.

Frequently Asked Questions

Can I add a fixed percentage to a permit value to estimate my garage conversion?
No validated universal multiplier is established here. Price design, approvals, construction and connections for your actual project and reconcile inclusions across proposals.
Are the permit tables current 2026 contractor prices?
No. They retain a historical extraction, with Los Angeles records through May 2023 and San Francisco reported through August 7, 2026. Permit records are not paid contractor invoices.
Do I pay impact fees on a garage converted to an ADU in California?
Not if the ADU has 750 square feet or less of interior livable space. Government Code 66311.5 bars impact fees at that size. Above 750 square feet, impact fees may be charged, but only in proportion to the square footage of the main house. Connection fees and application processing fees are separate.
How much is the school fee on a garage conversion?
It applies only if assessable space grows by more than 500 square feet, and an ADU under 500 square feet is treated as below that line. When it applies, the State Allocation Board's maximum Level I residential rate adopted in January 2026 is $5.38 per square foot, and some districts qualify for higher levels. Ask your district for its rate.
Will my water district charge a connection fee for a garage ADU?
Usually not when the ADU stays within the existing garage, with at most 150 square feet added for entry. State law bars requiring a new or separate utility connection, or a related connection fee or capacity charge, for that type of unit. Larger expansions can be charged a proportionate fee.
Do I have to replace the parking I lose when the garage becomes an ADU?
No. Government Code 66314 says that when a garage is converted to an ADU, the local agency shall not require those off-street parking spaces to be replaced.
Is there a Cost vs. Value figure for a garage conversion?
No. The 2025 report covers 28 projects, and none is a garage conversion. Its Accessory Dwelling Unit line describes a new 660 square foot building on a structural slab, so its cost does not describe a conversion.

Ready to find a pro?

Tell us what you are planning and where. A Renology advisor can help you explore contractor matching.

Find a Pro
  • Free for homeowners
  • Licensed, vetted local contractors
  • No obligation to hire

Sources

  1. City of Los Angeles, Building and Safety permit record, data through May 2023· accessed 2026-08-11
  2. City and County of San Francisco, Department of Building Inspection permit record, current through 7 August 2026· accessed 2026-08-11
  3. California HCD: ADU Handbook· accessed 2026-09-28
  4. CSLB: license lookup· accessed 2026-09-28
  5. California Government Code Section 66311.5 (ADU fees)· accessed 2026-10-09
  6. California Education Code Section 17620 (school facilities fees)· accessed 2026-10-09
  7. California Government Code Section 65995 (assessable space)· accessed 2026-10-09
  8. California Government Code Section 66000 (fee definition)· accessed 2026-10-09
  9. California Government Code Section 66314 (ADU standards)· accessed 2026-10-09
  10. California Government Code Section 66323 (ministerial ADU approval)· accessed 2026-10-09
  11. California Revenue and Taxation Code Section 71 (new construction assessment)· accessed 2026-10-09
  12. LADBS Information Bulletin P/BC 2026-150, Accessory and Junior Accessory Dwelling Units· accessed 2026-10-09
  13. State Allocation Board, Index Adjustment on the Assessment for Development, January 28, 2026· accessed 2026-10-09
  14. JLC, 2025 Cost vs. Value Report, national averages· accessed 2026-10-09
  15. JLC, Cost vs. Value project description, Accessory Dwelling Unit· accessed 2026-10-09
