A new or replacement driveway in Los Angeles typically costs between $14,000 and $30,000, a range reflecting material choices from basic asphalt to stamped concrete or interlocking pavers (Renology Cost Index, updated 2026-04). This price captures a standard two-car driveway of approximately 600 square feet, including demolition of the old surface, site preparation, and installation. Costs can start lower, in the $7,000 to $12,000 range, for simpler projects like asphalt resurfacing, a short driveway for a townhouse, or repairing a small section rather than a full replacement.
In a Nutshell
- Total Cost Range: $14,000, $30,000 for a full replacement of a standard driveway.
- Mid-Range Project Cost: Approximately $22,500 for a 600-square-foot brushed concrete driveway with proper demolition and base preparation.
- Typical Timeline: One to three weeks, including demolition, curing time for concrete, and final sealing.
- Biggest Surprise Line Item: Demolition and hauling of the old concrete or asphalt, which can add $2,500 to $4,500 to the total cost before any new material is even delivered.
What does a driveway actually cost in Los Angeles?
The final price tag for a Los Angeles driveway is a function of size, material, and site complexity. A straightforward asphalt replacement on a flat lot will occupy the lower end of the spectrum, while a custom paver installation on a sloped property with poor soil conditions will command a premium. Below are three tiers of project costs for a typical 600-square-foot driveway in the Los Angeles area.

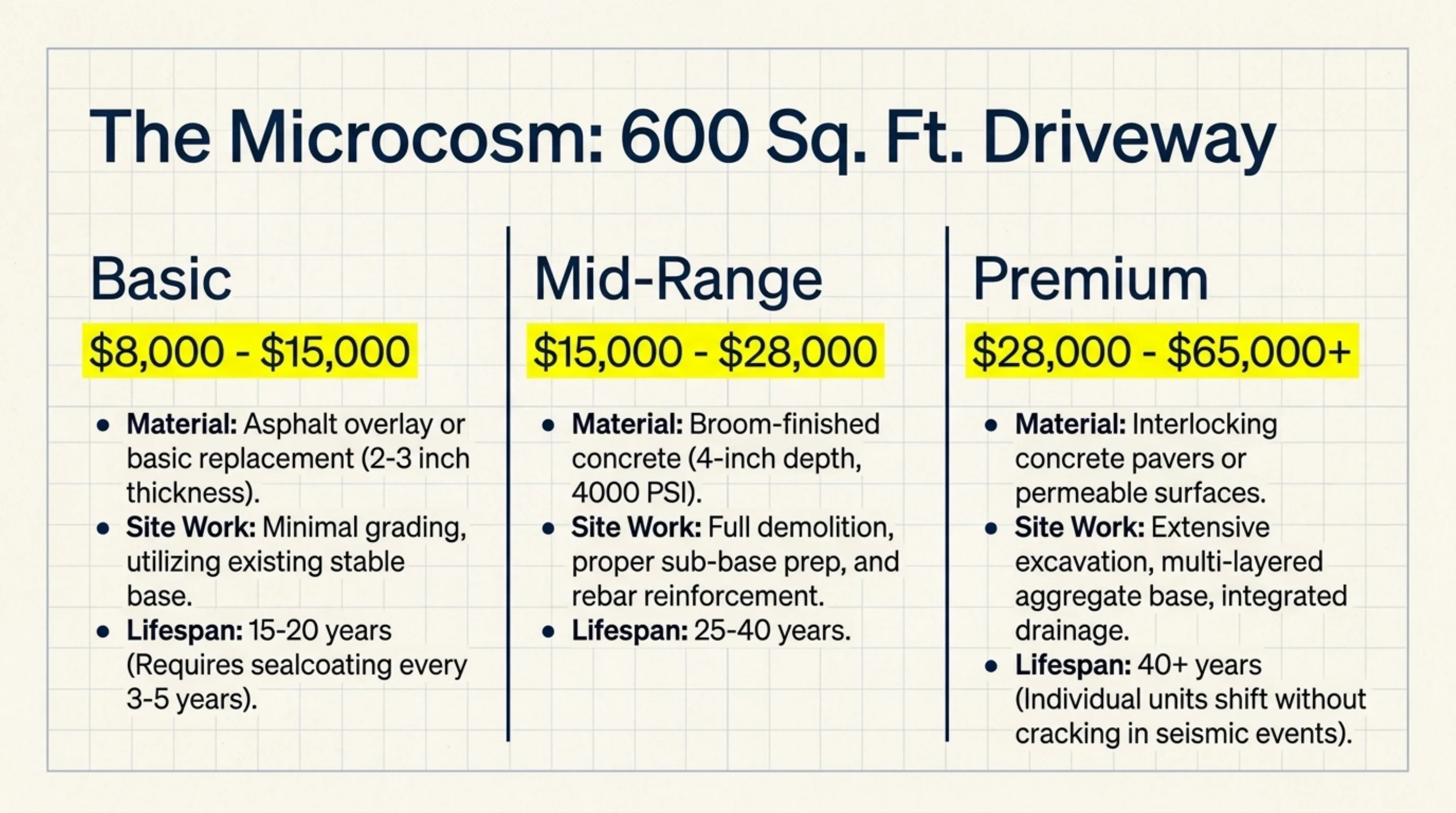

| Tier | Scope & Materials | Estimated Cost Range (2026) |
|---|---|---|
| Basic | Asphalt overlay or basic replacement; minimal grading; 2-3 inch thickness. | $8,000, $15,000 |
| Mid-Range | Broom-finished concrete (4-inch depth); full demolition of old surface; proper sub-base preparation and rebar reinforcement. | $15,000, $28,000 |
| Premium | Interlocking concrete pavers, stamped/colored concrete, or permeable surfaces; extensive site work; integrated drainage and lighting. | $28,000, $65,000+ |
For a mid-range, $22,500 concrete driveway project, the budget allocation is typically distributed as follows:
- Materials (concrete, rebar, sub-base): 35%
- Labor (demolition, forming, pouring, finishing): 30%
- Site Preparation & Demolition: 20%
- Permits, Fees & Mobilization: 5%
- Finishing & Sealing: 5%
- Contractor Overhead & Profit: 5%
The bottom of the cost range, below $14,000, generally applies to projects that are not full-scale replacements, such as resurfacing existing asphalt or repairing a limited, damaged section of a concrete driveway.
Why is it more expensive in Los Angeles than the surrounding region?
Installing a driveway in Los Angeles carries a cost premium compared to inland areas like Riverside or San Bernardino counties. This difference is driven by three primary factors: labor rates, logistical complexities, and stringent local regulations combined with neighborhood-specific requirements.
First, labor costs are significantly higher. According to the California Department of Industrial Relations prevailing wage data for Los Angeles County, skilled trades essential for driveway installation command high hourly rates. A Cement Mason can earn between $45 and $65 per hour, while an Operating Engineer for grading equipment can cost $55 to $75 per hour. These figures, which include benefits, are ten to twenty percent higher than in adjacent counties, directly inflating the largest component of the project budget after materials.
Second, material and equipment logistics in the dense urban environment of Los Angeles add substantial costs. Navigating city traffic with heavy equipment and concrete trucks increases fuel consumption and labor hours. Suppliers often add delivery surcharges for locations with difficult access or long transit times from quarries and batch plants, which are often located on the periphery of the metro area. These logistical costs can add $500 to $1,500 to a project compared to areas with less congestion.
Third, neighborhood premiums and local building codes introduce costs not present elsewhere. Municipalities like Santa Monica and Pasadena have strict ordinances regarding construction hours, noise, and dust control. Affluent neighborhoods such as Beverly Hills or Bel Air may have homeowner association rules that dictate material choices and aesthetic standards., the Los Angeles Department of Building and Safety (LADBS) has specific requirements for grading, drainage, and seismic considerations due to the region's expansive clay soils and fault lines. This often requires more solid sub-base preparation and reinforcement, adding thousands to the site work budget.
What do real Los Angeles homeowners spend in 2026?
Three representative projects from 2026, scoped similarly, reconstructed from Renology's Project of the Day network and used here in aggregate form:
- Sherman Oaks ($23,500): This project involved replacing a cracked 650-square-foot asphalt driveway with standard 4-inch thick, 4000 PSI concrete. The lot had a slight slope, requiring extra grading and the installation of a channel drain at the garage entrance to prevent water intrusion. The cost included demolition, hauling, forming, pouring, rebar reinforcement, a broom finish, and sealing. The project took two weeks from demolition to final cleanup.
- Eagle Rock ($29,000): A homeowner replaced a 500-square-foot concrete driveway with permeable interlocking pavers to better manage stormwater runoff on their property. The higher cost reflects the more expensive paver material ($8, $12 per sq. ft.) and the more intensive labor required for the multi-layered sub-base of open-graded aggregate needed for proper drainage. This choice, while more expensive, helps reduce the homeowner's contribution to city storm sewers.
- Mar Vista ($16,200): This was a straightforward replacement of a 450-square-foot driveway. The owner chose new asphalt for its cost-effectiveness and quick installation. The project was on a flat, stable lot, requiring minimal site prep beyond removing the old, crumbling asphalt and compacting the existing base. The entire job was completed in four days, minimizing disruption for the homeowner.
Where does the money actually go?
3 Los Angeles driveway contractors, editor-screened. 4 questions.
See my 3 matchesInitial contractor quotes can sometimes feel incomplete because they bundle major activities. Understanding the specific line items that comprise the total cost is essential for comparing bids and appreciating the scope of work. Many of these costs are for work that happens below the surface and is invisible upon completion, but critical for longevity.
- Demolition and Disposal ($2,500, $4,500): This covers the labor and equipment (jackhammers, skid steers) to break up the existing driveway and the fees for hauling and legally disposing of several tons of concrete or asphalt debris.
- Site Grading and Soil Compaction ($1,800, $3,500): The area must be excavated and graded to ensure proper slope for drainage away from the home's foundation. The soil is then compacted to create a stable base, a crucial step for preventing sinking and cracking, especially in LA's expansive soils.
- Sub-base Installation ($1,500, $2,800): A layer of crushed rock or aggregate, typically four to six inches deep, is spread and compacted over the soil. This provides a load-bearing foundation and facilitates drainage.
- Drainage Systems ($2,000, $5,000): If the driveway's slope directs water toward the garage or foundation, a channel drain or French drain system is necessary. This is a non-negotiable cost to prevent significant water damage.
- Permits and Plan Check Fees ($800, $2,200): The City of Los Angeles requires permits for most new driveway installations. This cost covers the permit itself, any required plan submissions to LADBS, and potentially a city inspection.
- Reinforcement ($1,200, $2,500): For concrete driveways, a grid of steel rebar or wire mesh is installed before the pour. This reinforcement is what gives the concrete tensile strength, helping it resist cracking under the weight of vehicles and from soil movement.
- Concrete Pumping Truck ($600, $1,200): If the driveway is not easily accessible by a concrete mixer truck, a pumper truck is required to transport the concrete from the street to the site. This is a common necessity in hillside communities or properties set back from the road.
- Finishing and Sealing ($750, $1,800): This includes the labor for the final surface finish (e.g., broom, salt, or stamped finish) and the application of a protective sealant after the concrete has cured. Sealing helps resist stains, water penetration, and UV damage.
What no one else covers
The conversation about driveway materials in Los Angeles often centers on aesthetics and initial cost: the classic look of concrete versus the economy of asphalt or the curb appeal of pavers. What is frequently missed in this analysis is the long-term financial and environmental calculus of permeability. In a region defined by cyclical drought and increasing regulations on water use, the choice between an impermeable and a permeable driveway surface has consequences that extend far beyond the property line.
An impermeable surface, like standard concrete or asphalt, functions like a miniature watershed, directing every drop of rain into the street and onward into the municipal storm drain system. This contributes to urban runoff pollution and wastes a valuable resource. A permeable driveway, constructed with specialized pavers or porous concrete, allows rainwater to percolate through the surface and into the ground below, recharging local aquifers. The upfront cost is higher, often 25-40% more than standard concrete, due to the specialized materials and the deeper, multi-layered aggregate base required for filtration and stability. A $22,000 standard concrete driveway might cost $28,000 to $31,000 if built with permeable pavers.
However, this initial premium can be offset over time. The Los Angeles Department of Water and Power (LADWP) and other local water agencies periodically offer rebates for features that improve water conservation and stormwater capture. While programs vary, a homeowner could potentially recoup $1,000 to $3,000 of the installation cost. More importantly, by retaining water on-site, a permeable system can passively irrigate adjacent landscaping, reducing the need for sprinkler use and lowering water bills. From a regulatory perspective, as the city continues to tighten stormwater management rules (LID, or Low Impact Development, ordinances), choosing a permeable surface now can be a form of future-proofing, ensuring compliance with regulations that may become mandatory for future renovations. This transforms the driveway from a simple utility into an active part of a home's water management strategy, a consideration few homeowners make but one that has growing financial relevance in Southern California.
What stops a Los Angeles driveway from running over budget?
Even with a detailed quote, driveway projects can exceed their initial budget. Understanding the common causes of cost overruns allows for better planning and mitigation.
- Unforeseen Site Conditions: This is the most frequent cause of budget increases. During excavation, a contractor might discover excessively soft soil, a high water table, or large tree roots that must be removed. In Los Angeles, encountering expansive clay soil that requires more extensive excavation and a thicker sub-base is common. Buried debris from previous construction or undocumented utility lines can also halt work and require costly remediation.
- Scope Creep: A project's scope can expand organically once work begins. A homeowner might decide to add a matching walkway to the front door, extend the driveway to create more parking space, or add a short retaining wall along the edge. While these additions may seem minor, they add material and labor costs that were not part of the original agreement and can easily inflate the final bill by 15-30%.
- Permitting and Inspection Delays: Navigating the bureaucracy of the Los Angeles Department of Building and Safety (LADBS) can be unpredictable. If plans are rejected and require revision, or if an inspector requires changes to the work already completed (such as the depth of the sub-base or the placement of rebar), the project timeline is extended. These delays result in added labor costs and may incur fees for rescheduling material deliveries.
To prepare for these possibilities, a financial buffer is essential. The National Association of Home Builders recommends a ten to fifteen percent contingency on renovations in homes over thirty years old. This same principle applies to exterior projects where subsurface conditions are unknown.
What should your Los Angeles contractor include in the quote?
A detailed, professional quote is the foundation of a successful project. It should leave no room for ambiguity. Vague quotes are a red flag. Your contractor's proposal should be a multi-page document that specifies the following fourteen items at a minimum:
- Scope of Work: A precise description of the project, including the exact square footage of the driveway to be removed and replaced.
- Demolition and Debris Removal: Explicit mention of the removal and legal disposal of the old driveway material.
- Site Preparation Details: The depth of excavation and the method of soil compaction.
- Sub-base Specifications: The type and depth (e.g., "4 inches of compacted Class II aggregate base") of the sub-base material.
- Material Specifications: The exact type of primary material, including concrete strength (e.g., "4000 PSI concrete"), paver manufacturer and model, or asphalt grade.
- Material Thickness: The final planned thickness of the concrete slab or asphalt layer (e.g., "4-inch nominal thickness").
- Reinforcement Plan: The type and spacing of reinforcement (e.g., "#3 rebar on a 18-inch grid").
- Drainage Plan: Details of any included channel drains, French drains, or grading to ensure proper water runoff.
- Finish Details: The specific finish for the surface (e.g., "broom finish," "salt finish," or specific paver pattern).
- Sealing: The type of sealant to be applied after curing and how many coats.
- Permit Responsibility: A clear statement on who is responsible for securing and paying for the necessary LADBS permits. Securing the correct permits from the Los Angeles Department of Building and Safety (LADBS) is a critical step; you can find a detailed walkthrough in our Los Angeles driveway permit playbook for 2026.
- Project Timeline: An estimated start date and completion date, including allowances for concrete curing.
- Payment Schedule: A clear breakdown of payments tied to project milestones (e.g., deposit, upon completion of demolition, final payment).
- Warranty Information: A written warranty covering both materials and workmanship for a specified period.
Renology Take
The most common point of failure for Los Angeles driveways, both in terms of physical integrity and budget, is an underestimation of what lies beneath the surface. Homeowners understandably focus on the visible elements: the color of the pavers, the pattern of stamped concrete, the smoothness of the finish. The meta-pattern we observe is a failure to properly vet the contractor's plan for the unseen foundation. A driveway is an engineered system, and in a region with challenging expansive clay soils and seismic activity, the sub-base and drainage are more critical than the surface itself. A contractor who saves money by skimping on excavation depth, sub-base material, or compaction is setting the homeowner up for premature failure. Cracking, sinking, and heaving within five to seven years are the direct result. The key is to shift focus during the bidding process from the surface aesthetics to the structural preparation, asking detailed questions about soil compaction, base thickness, and reinforcement. A beautiful driveway on a poor foundation is a costly illusion.
Sources & Methodology
Renology reviews public permit and labor signals, supplier pricing, remodeler quote patterns, comparable projects, the Renology Cost Index, and the Renology Methodology. Cost references are planning ranges for Los Angeles driveway projects, not fixed bids.
- Renology Project of the Day (POTD) Network Data, Los Angeles MSA, 2025-2026.
- Remodeling Magazine, 2026 Cost vs. Value Report, Pacific Region.
- Los Angeles Department of Building and Safety (LADBS), Permit Fee Schedule, 2026.
- California Department of Industrial Relations, Prevailing Wage Determinations for Los Angeles County, 2026.
- National Association of Home Builders (NAHB), Construction Cost Survey, 2026.
- Interlocking Concrete Pavement Institute (ICPI), Construction Specifications.
- National Ready Mixed Concrete Association, Residential Concrete Standards.
- U.S. Bureau of Labor Statistics, Producer Price Index (PPI) for Concrete and Asphalt, 2026.
- Los Angeles Department of Water and Power (LADWP), Rebate Program Guidelines, 2026.
This article is from The Renology Magazine, the renovation magazine and contractor-advisory for homeowners in Southern California, San Diego, and Greater Seattle. Want more renovation breakdowns? Search "The Renology Magazine" on Google.
Sources & methodology
How Renology builds this guide
Renology combines public permit and labor signals, supplier pricing, remodeler quote patterns, and editorial review of comparable projects. Cost references are planning ranges, not fixed bids, because site conditions, materials, access, permits, and finish level can change the final price.
- Benchmarked against the Renology Cost Index, related service guides, and the Renology Methodology.
- Reviewed for Los Angeles market context when a local market is available.
- Focused on driveway scope, materials, timeline, contractor risk, and budget drivers.
Los Angeles · pre-screened
Get 3 Los Angeles driveway bids in 48 hours.
Our editors already vetted Los Angeles driveway contractors. Answer 4 questions and we send 3 written bids inside 48 hours, with the real price for your scope, not their inflated first-call number.
- Free, no commission
- Pre-screened locally
- Bids inside 48 hours
Takes about 60 seconds. We'll text you when bids arrive.
