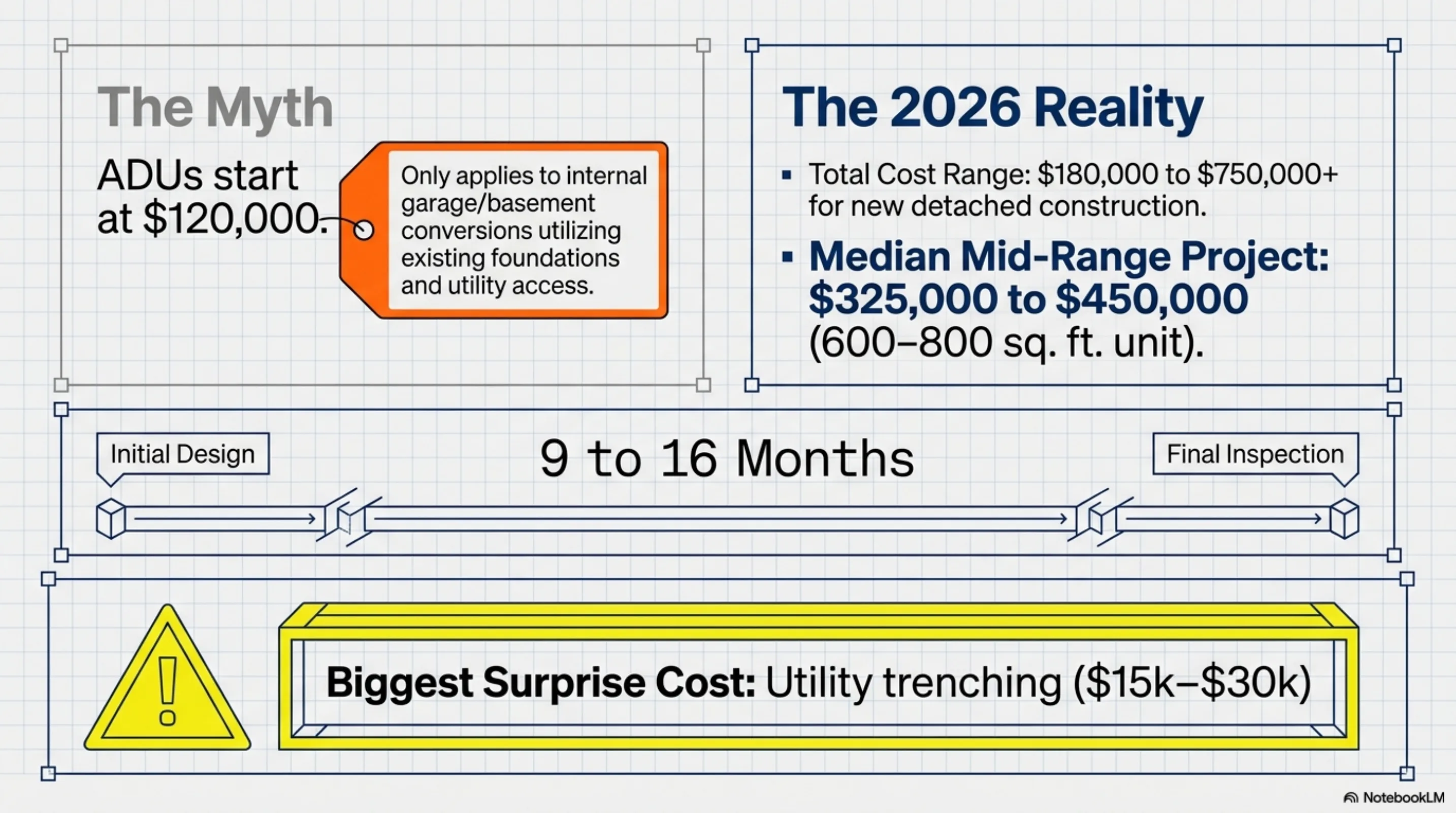

Building an Accessory Dwelling Unit (ADU) in San Diego in 2026 costs between $180,000 and $750,000, with a median project price for a mid-range, detached unit falling between $325,000 and $450,000. While a project can start lower, around $120,000, these figures typically represent internal conversions of existing space, like a garage or basement, with existing foundations and utility access. For new, detached construction, homeowners should anchor their expectations to the higher end of this spectrum, reflecting the true cost of building a small home from the ground up in Southern California.
In a Nutshell
- Total Cost Range: $180,000 to $750,000+ for a new detached ADU.
- Mid-Range Project Cost: $325,000 to $450,000 for a 600-800 square foot unit with standard finishes.
- Typical Timeline: Nine to sixteen months from initial design to final inspection.
- Biggest Surprise Cost: Utility connections. Trenching and connecting to sewer, water, and power can add $15,000 to $30,000, a line item often underestimated in initial budgets.
What does an ADU actually cost in San Diego?
3 San Diego ADU builders, editor-screened. 4 questions.
See my 3 matchesThe total cost for a San Diego ADU is a function of size, site complexity, and finish quality. We have segmented project costs into three tiers based on an analysis of city permit data and contractor estimates. The table below outlines typical all-in costs for detached, new-construction ADUs.

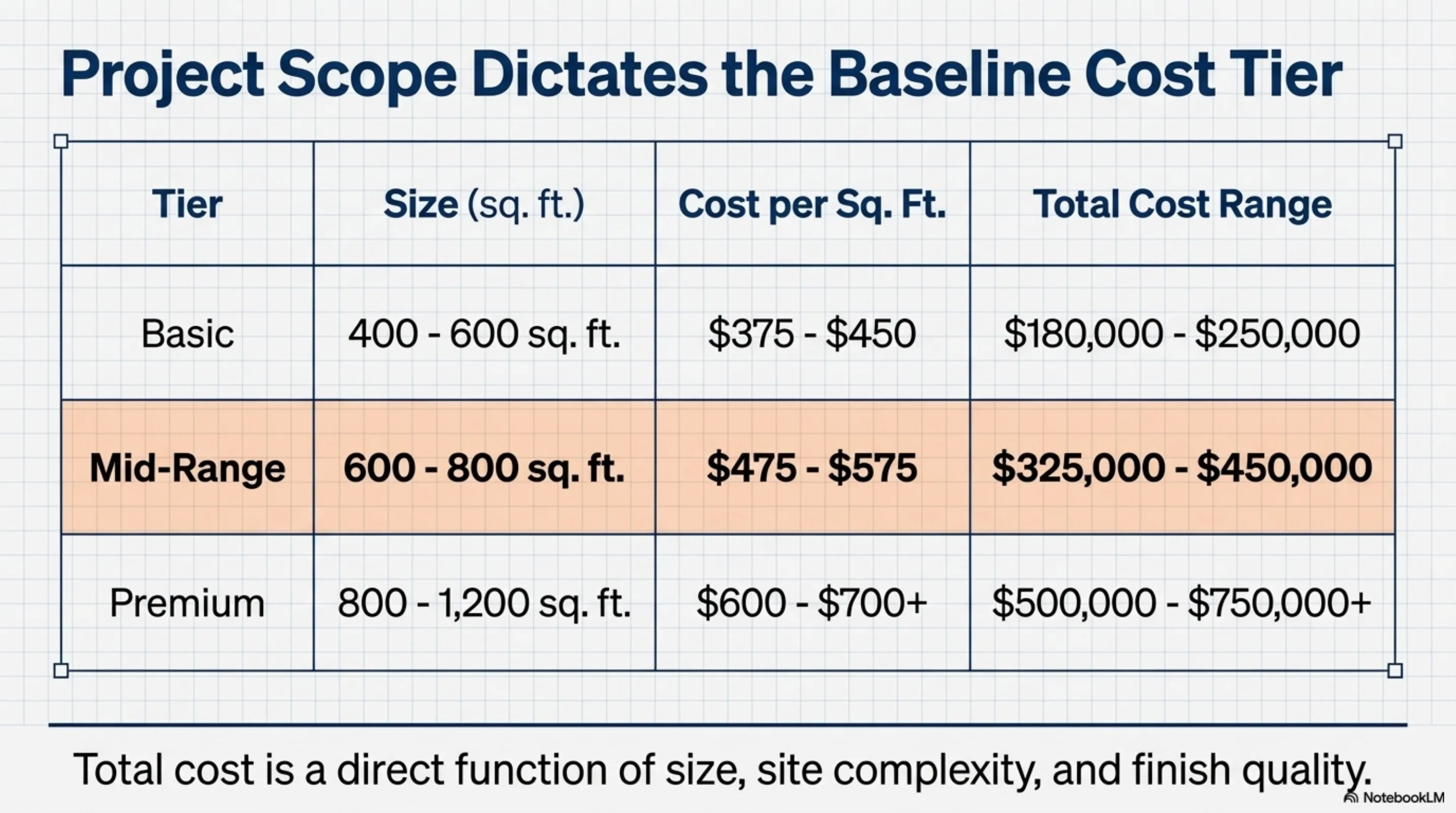

| Tier | Size (sq. ft.) | Cost per Sq. Ft. | Total Cost Range |
|---|---|---|---|
| Basic | 400, 600 | $375, $450 | $180,000, $250,000 |
| Mid-Range | 600, 800 | $475, $575 | $325,000, $450,000 |
| Premium | 800, 1,200 | $600, $700+ | $500,000, $750,000+ |
A typical mid-range ADU project's budget allocates funds across several major categories. Here is a representative breakdown:
- Site Work & Foundation: 15%
- Framing & Structure: 20%
- Exterior Finishes (Roof, Siding, Windows): 15%
- Major Systems (Plumbing, Electrical, HVAC): 20%
- Interior Finishes & Fixtures: 20%
- Soft Costs (Design, Engineering, Permits): 10%
The lowest cost estimates, often seen in advertisements, typically refer to garage conversions or other projects that use an existing foundation and structure, which eliminates a significant portion of site work and framing costs.
Why is it more expensive in San Diego than the rest of Southern California?
Three factors drive the high cost of a San Diego ADU: improved labor rates, complex site conditions, and neighborhood-specific premiums. While material costs are relatively consistent across the region, these three elements create a notable price differential.
1. Labor Rates: The demand for skilled construction labor in San Diego far outstrips supply, leading to higher wages. According to the California Department of Industrial Relations prevailing wage data for San Diego County, hourly rates for journeyman carpenters, electricians, and plumbers are ten to twenty percent higher than in neighboring counties like Riverside or Imperial. This premium affects every stage of the build, from foundation to finish work, and is a primary driver of the overall project cost.
2. Site Complexity and Topography: San Diego's canyons, coastal bluffs, and varied soil types present significant engineering and site preparation challenges. Lots in areas like Mount Soledad or along the coast often require extensive grading, retaining walls, and deeper foundations, adding $20,000 to $60,000 in site work costs compared to a flat lot inland. many older neighborhoods have aging utility infrastructure, which can complicate tie-ins and trigger costly upgrades.
3. Neighborhood Premiums and Coastal Regulations: Construction in high-value neighborhoods such as La Jolla, Del Mar, and Coronado carries a premium. Contractors face stricter logistical challenges, limited work hours, and higher client expectations for finishes., projects within the coastal zone are subject to additional review by the California Coastal Commission, which can add months to the permitting timeline and require more expensive, salt-air-resistant materials, increasing the budget by another five to ten percent.
What do real San Diego homeowners spend in 2026?
Three representative projects from 2026, scoped similarly, reconstructed from Renology's Project of the Day network and used here in aggregate form:
Project 1: Garage Conversion in Clairemont. A 400-square-foot studio ADU converted from an existing two-car garage. The project involved reinforcing the existing foundation, adding a bathroom and kitchenette, and installing a new mini-split HVAC system. The homeowner chose builder-grade finishes to control costs. The all-in price was $145,000, illustrating the savings of using an existing structure.
Project 2: Detached ADU in North Park. A 650-square-foot, one-bedroom detached ADU built in the backyard of a craftsman home. The project required 40 feet of trenching for new sewer and water lines. Finishes were mid-range, with quartz countertops and LVP flooring. The total cost was $360,000, which is squarely in the median for a new build of this size.
Project 3: Two-Story ADU in Carlsbad. A 1,100-square-foot, two-bedroom unit built over a new two-car garage. The lot had a slight slope, requiring a stepped foundation. Finishes were premium, including custom cabinetry, a solar panel array, and bifold patio doors to capture coastal breezes. The final cost, including significant engineering and design fees, reached $680,000.
Where does the money actually go?
An initial quote from an ADU contractor San Diego might seem comprehensive, but several critical line items are often excluded or listed as allowances. Homeowners must account for these costs to build a realistic budget.
- Soils Report and Geotechnical Survey: Required by the city for most new foundations, especially on slopes. Cost: $2,500, $5,000.
- Structural Engineering: Translates architectural plans into structural reality, essential for seismic and soil stability. Cost: $6,000, $15,000.
- Utility Connection Fees (SDG&E, Water): Beyond the physical labor, the utility providers charge significant fees to connect a new unit to the grid. Cost: $5,000, $15,000.
- City Plan Check and Permit Fees: Fees paid to the San Diego Development Services Department (DSD) for reviewing plans and issuing permits. Cost: $8,000, $20,000.
- Fire Sprinkler System: Often required if the ADU is a certain distance from the street or if the main house has them. Cost: $7,000, $12,000.
- Landscaping and Hardscaping: Restoring the yard after construction, including irrigation, plants, fences, and patios. Cost: $5,000, $25,000.
- Solar Panel System: California's Title 24 energy code mandates solar panels for all new residential construction, including detached ADUs. Cost: $10,000, $18,000.
What stops a San Diego ADU from running over budget?
Three primary issues cause budget overruns in San Diego ADU projects: unforeseen site conditions, homeowner scope creep, and permitting delays.
First, surprises below ground are common. Discovering undocumented utility lines, poor soil composition requiring deeper footings, or large rock formations during excavation can halt work and add thousands to the site prep budget. Second, scope creep is a constant risk. Changing your mind on tile, adding a window, or upgrading appliances after construction has begun creates a cascade of change orders and labor costs. Finalizing all selections before breaking ground is the most effective defense.
Finally, navigating the cityβs permitting process can be slow. If plans are submitted incomplete or require revisions to comply with zoning or building codes, the resulting delays can increase carrying costs and potentially push the project into a season with less favorable weather. The National Association of Home Builders recommends a ten to fifteen percent contingency on renovations in homes over thirty years old. For new ADU construction, a similar contingency of ten percent is prudent to cover these potential setbacks.
For a detailed walkthrough of the local process, consult our guide to the San Diego ADU permit playbook for 2026.
What should your San Diego contractor include in the quote?
A detailed, fixed-price quote is essential for financial control. Ensure your contract with your ADU contractor in San Diego itemizes the following:
- All design, engineering, and architectural fees.
- Costs for all city permits and plan check fees.
- A detailed scope of work, specifying all materials and model numbers for fixtures.
- Site preparation, including demolition, grading, and excavation.
- Foundation work, including concrete and rebar specifications.
- Framing, sheathing, and structural hardware.
- Roofing, siding, windows, and exterior doors.
- All plumbing, electrical, and HVAC systems, including trenching.
- Insulation and drywall.
- Interior and exterior paint.
- All interior finishes: flooring, tile, cabinetry, and countertops.
- Labor costs and subcontractor fees.
- A project timeline with key milestones.
- Site cleanup and debris removal.
Sources & Methodology
Cost ranges in this guide draw on the following named industry sources, public agency datasets, and Renology editorial research.
- California Department of Industrial Relations, Prevailing Wage Determinations (2026)
- City of San Diego Development Services Department, Permit Fee Schedule (2026)
- Remodeling Magazine, Cost vs. Value Report (2026)
- National Association of Home Builders (NAHB), Construction Cost Survey (Q4 2025)
- Zillow Rental Market Trends, San Diego Metro (Q1 2026)
- Renology Project of the Day (POTD) Network, San Diego Data (2023β2026)
Renology Take
The primary reason San Diego ADU projects exceed initial expectations is the disconnect between a simple cost-per-square-foot estimate and the total project cost. Homeowners often anchor to a number like $500 per square foot, calculating a 600-square-foot unit should cost $300,000. They fail to account for the fixed costs that are independent of size. Soft costs like design, engineering, and permits can be $40,000 regardless of whether the unit is 400 or 800 square feet. Similarly, utility hookups can cost $25,000 for any size unit. This means smaller ADUs have a disproportionately higher cost per square foot. Understanding that a significant portion of the budget is fixed, not variable, is the key to developing a realistic financial plan for an ADU in San Diego in 2026.
Get 3 San Diego ADU bids in 48 hours.
Our editors already screened San Diego ADU builders. Answer 4 questions; we send 3 written bids inside 48 hours, with the real price for your scope, not their inflated first-call number.
Send my 3 bidsFree. No commission. If a match doesn't fit, we'll send another.
