How Long a Siding Replacement Really Takes in Sacramento (2026)

A Sacramento siding replacement takes 4 to 8 weeks, but hidden dry rot can easily push it to 10. We walk through the four phases, from permits and tear-off to final inspection, with real 2026 costs.

Renology Editorial Team·April 2026·Updated July 2026·15-min read
Reviewed by Renology Editorial Team, Editorial|Last updated: July 2026

A full siding replacement for a typical Sacramento home takes between four and eight weeks from the day the crew arrives to the final inspection sign-off. The timeline can start lower, around three weeks, for a simple re-side on a newer, smaller home in a development with no surprises under the skin. But for most of the older housing stock in neighborhoods like Land Park or Curtis Park, you plan for eight weeks and hope for six. The single biggest delay we find on the job is discovering extensive dry rot or pest damage in the wall sheathing after tear-off. It’s a mandatory stop-work situation until the structure is made sound. This isn't a maybe; on a pre-1980s home, it's a probability you need to budget time and money for from day one.

In a Nutshell

  • Total Project Timeline: 4 to 8 weeks is the realistic range for a standard single-family home in Sacramento.
  • The Four Phases: Your project will move through four distinct stages: Planning, Materials, and Permits; Demolition and Substrate Repair; Installation and Trim; and finally, Painting, Cleanup, and Final Inspection.
  • Biggest Delay Risk: Uncovering hidden structural damage. Dry rot, termite trails, or compromised framing beneath the old siding can add one to three weeks and significant cost to the project.
  • Contingency Planning: Don't start without a cash reserve. The National Association of Home Builders recommends a ten to fifteen percent contingency on renovations in homes over thirty years old. In Sacramento, I'd lean toward fifteen.

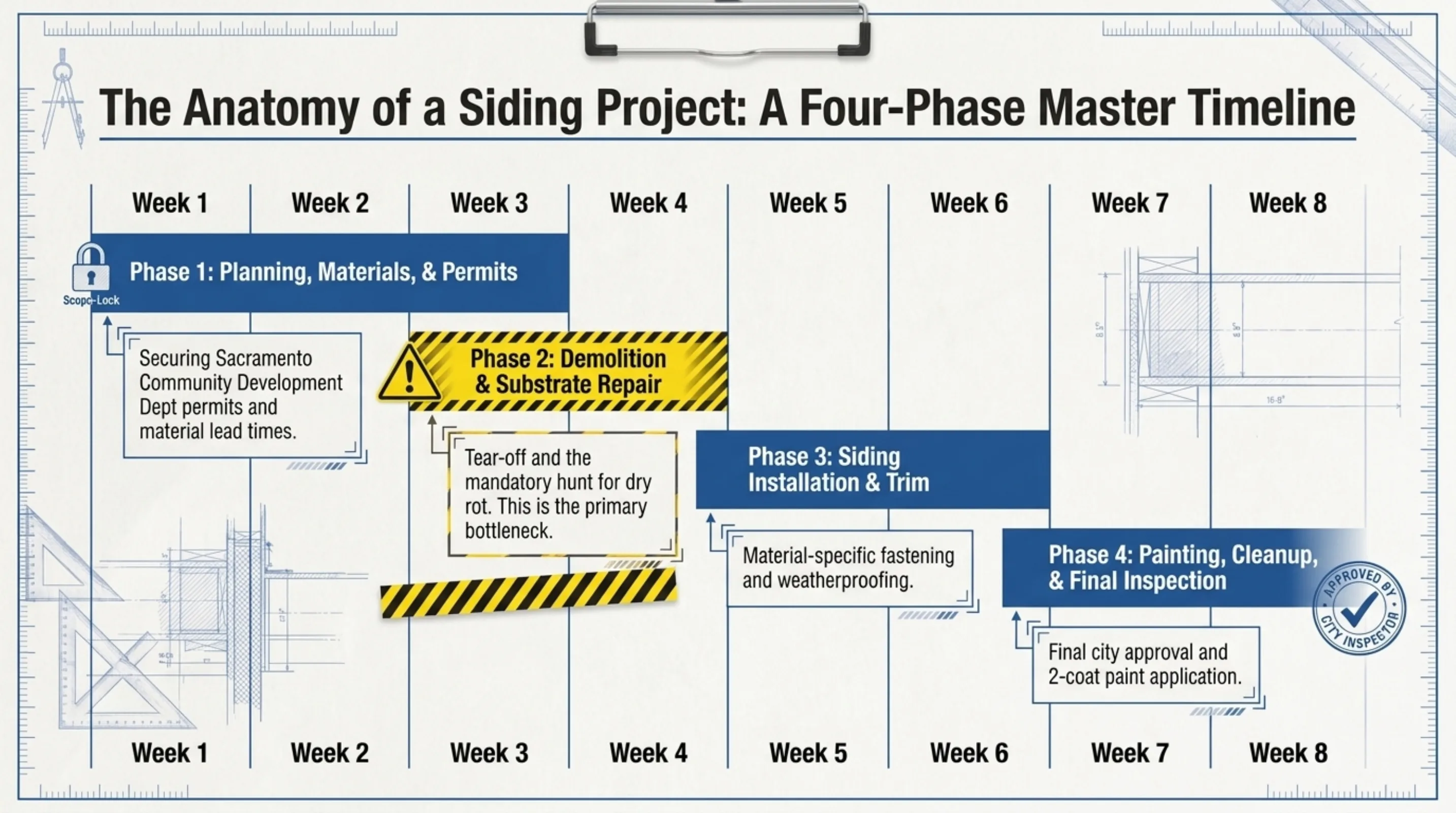

Phase 1: Planning, Materials, and Permits (Weeks 1-3)

This initial phase is all about preparation and paperwork, and it sets the pace for the entire job. First, you and your siding contractor lock the scope. This means choosing the exact material (fiber cement, vinyl, wood), the color, the trim style, and any related work like new gutters or window wrapping. Once the scope is locked, materials are ordered. This is a critical step; lead times for specific James Hardie ColorPlus shades or custom-milled wood can be several weeks, and you don't want a crew waiting on a pallet of siding. While many like-for-like siding jobs in Sacramento don't require a permit, any change in material type or work that involves structural repairs absolutely will. Your contractor should pull the permit from the Sacramento Community Development Department. This isn't a place for homeowner heroics; let the pros handle the city. The most common holdup here is indecision. A homeowner who can't finalize a color choice can delay the material order and push the project back before a single nail is pulled. A clear plan is a fast plan.

Phase 2: Demolition and Substrate Repair (Weeks 3-4)

Here's where the project gets real, and where the budget can take a hit. The crew arrives and begins the tear-off, removing every piece of old siding and trim. This is a noisy, dusty process that generates a surprising amount of debris. Once the walls are stripped, we see what we're really dealing with. The condition of the sheathing and the weather-resistive barrier (WRB) underneath is revealed. In older Sacramento homes, it's common to find sections of plywood or OSB that have turned to mush from years of water intrusion around poorly flashed windows. We look for the tell-tale signs of dry rot and check the integrity of the framing members. Any compromised wood must be cut out and replaced. This isn't optional; it's a structural necessity and a code requirement. The house's ability to carry its load depends on a sound frame. This is also when we install a new, high-quality WRB, properly lapped and taped. This is your home's raincoat. Skimping here is guaranteeing a failure down the line. A good siding contractor in Sacramento will walk you through any necessary repairs with photos and a clear change order before proceeding.

Phase 3: Siding Installation and Trim (Weeks 4-6)

With a solid, dry, and protected substrate, the new siding can go on. This is the phase where your house starts to look like a home again. The installation technique varies significantly by material. Fiber cement siding, popular in Sacramento for its fire resistance and stability in the heat, is heavy and requires special tools for cutting and a precise nailing pattern to prevent cracking. The manufacturer's instructions are not suggestions; they are warranty requirements. Vinyl siding, a more budget-friendly option, must be hung loosely on its fasteners to allow for the significant expansion and contraction it experiences in the Central Valley's temperature swings. Nailing it tight will cause it to warp and buckle within the first summer. Wood siding requires careful flashing details and back-priming to prevent moisture from getting behind the boards. During this phase, the crew will also install all the trim pieces around windows, doors, and corners, which defines the final look. The job site should be kept clean daily, and the foreman should be inspecting the work as it progresses, not just at the end.

Phase 4: Painting, Cleanup, and Final Inspection (Weeks 6-8)

The final stretch involves finishing touches that make all the difference. If you chose pre-finished siding, this phase is much shorter, focusing on caulking, sealing, and final details. If your siding is primed, the painters arrive now. A professional paint job includes extensive masking of windows, doors, and fixtures, as well as protecting landscaping. They should apply two full coats of high-quality exterior paint. This is your siding's primary defense against sun and rain. Once painting is complete, the crew performs a final, thorough cleanup of the entire property, including using magnetic rollers to pick up stray nails. The last step before you write the final check is the city's final inspection. The inspector from the Sacramento Community Development Department will visit the site and review the work against the approved plans and building codes. They'll check for proper flashing, correct fastening, and general workmanship. Once they sign off on the inspection card, the project is officially complete, and your home is protected for decades to come.

Information Gain: What No One Else Covers About Siding in Sacramento

3 Sacramento siding contractors, editor-screened. 4 questions.

A Sacramento homeowner discusses siding samples with a Renology contractor in their Land Park backyard.See my 3 matches

Most articles on siding focus on curb appeal and basic material comparisons. They miss the factors that actually drive siding sacramento cost and long-term performance in the Central Valley. First, let's talk about the climate. Sacramento isn't just hot; it's a cycle of intense, dry heat and damp, cool winters. This thermal cycling is brutal on building materials. Low-grade vinyl siding, with its high coefficient of thermal expansion, will visibly warp and buckle in a 110-degree July afternoon if not installed with extra room for movement. This is why a siding contractor sacramento who just flies through the job can leave you with a mess in six months. Fiber cement is far more dimensionally stable, making it a superior choice for our climate, despite the higher upfront cost. Second is the increasing importance of fire-resistant materials. As Wildland-Urban Interface (WUI) zones expand, California's Title 24 building codes are becoming more stringent. Choosing a non-combustible siding like fiber cement isn't just a good idea; it can be a code requirement and an insurance mandate. This is a conversation you must have with your contractor. Third, understand the labor. Siding isn't a low-skill trade. A certified installer for a product like James Hardie has been trained on specific fastening schedules and clearance requirements that are essential for the product's 30-year warranty. According to the California Department of Industrial Relations prevailing wage data for Sacramento County, skilled carpenters and siding installers command a wage that reflects this expertise. Hiring a cheaper, uncertified crew to save a few thousand dollars can void a warranty worth tens of thousands. The cost of a siding project is not just in the materials, but in the skill to install them correctly for the specific environmental stresses of our region.

Three Representative Projects from 2026

Three representative projects from 2026, scoped similarly, reconstructed from Renology's Project of the Day network and used here in aggregate form:

  • East Sacramento 1940s Bungalow: A 1,650-square-foot home requiring a full tear-off of old wood siding. The project involved replacing about 20% of the wall sheathing due to dry rot. The owner chose pre-finished James Hardie fiber cement siding. Total cost: $34,500. Total time from start to final inspection: seven weeks.
  • Folsom 1990s Tract Home: A larger, 2,500-square-foot two-story home. The existing vinyl siding was failing due to sun damage. This was a straightforward remove-and-replace with a high-quality, insulated vinyl siding. No significant substrate repairs were needed. Total cost: $26,000. Total time: four weeks.
  • Land Park 1920s Tudor Revival: A 2,200-square-foot home with a mix of original siding and stucco. The project was complex, requiring careful integration of new fiber cement siding with the existing stucco, plus custom trim work to match the home's historic character. Significant structural repairs were needed around the original windows. Total cost: $58,000. Total time: nine weeks.

What Can Compress This Timeline

The homeowner who saves two weeks does these three things before signing a contract. First, they make every single decision upfront. They have the siding material, profile, color, and trim package selected and written into the contract. There are no 'game-time decisions.' This allows the contractor to order all materials at once and schedule the job with confidence. Scope-lock is your best tool for speed. Second, they opt for pre-finished materials. Using pre-painted fiber cement or a premium vinyl product completely eliminates the painting phase. This alone can shave one to two weeks and several days of job site disruption off the schedule. Third, they prepare the site themselves. Before the crew arrives, they clear a five-foot perimeter around the entire house. This means moving patio furniture, rolling up hoses, trimming back shrubs, and removing planter boxes. A clear site is a safe and efficient site, saving the crew hours of non-productive prep work.

What Blows It Up

Three things reliably turn a six-week job into a ten-week headache. The number one issue is hidden damage. Tearing off the old siding on a 1950s ranch and finding that the entire bottom plate is rotted out is a project-altering discovery. It stops all siding work until a framing crew can make repairs, and it can add thousands to the siding sacramento cost. Second are homeowner-driven change orders. Deciding mid-project that you want to replace a few windows 'while you're at it' sounds simple, but it's not. It requires new measurements, ordering, and a complete shift in the work sequence. Any change order, big or small, breaks the momentum. Third is weather. While Sacramento has a lot of clear weather, a string of unexpected winter storms can halt work for days, especially if the walls are open and exposed. You can't install siding in a downpour. The National Association of Home Builders recommends a ten to fifteen percent contingency on renovations in homes over thirty years old. Heed that advice.

What Should Be in Your Contractor's Schedule

A one-page estimate is not a schedule. A professional contractor's project schedule should be a detailed document with specific milestones. Insist on seeing these line items before you sign:

  1. Final material selection and scope-lock date.
  2. Date materials will be ordered.
  3. Estimated material delivery date to the job site.
  4. Projected start date for on-site work (demolition).
  5. Milestone for completion of demolition and substrate assessment.
  6. Time allowance for potential structural repairs (e.g., 3-5 days).
  7. Start and completion dates for weather-resistive barrier and flashing.
  8. Start and completion dates for siding and trim installation.
  9. Start and completion dates for painting and caulking (if applicable).
  10. Date for final inspection request submitted to the city.
  11. Date for final homeowner walkthrough and punch list completion.

This level of detail holds both parties accountable. Get familiar with the city's process using our permit playbook to understand the inspection milestones.

Renology Take

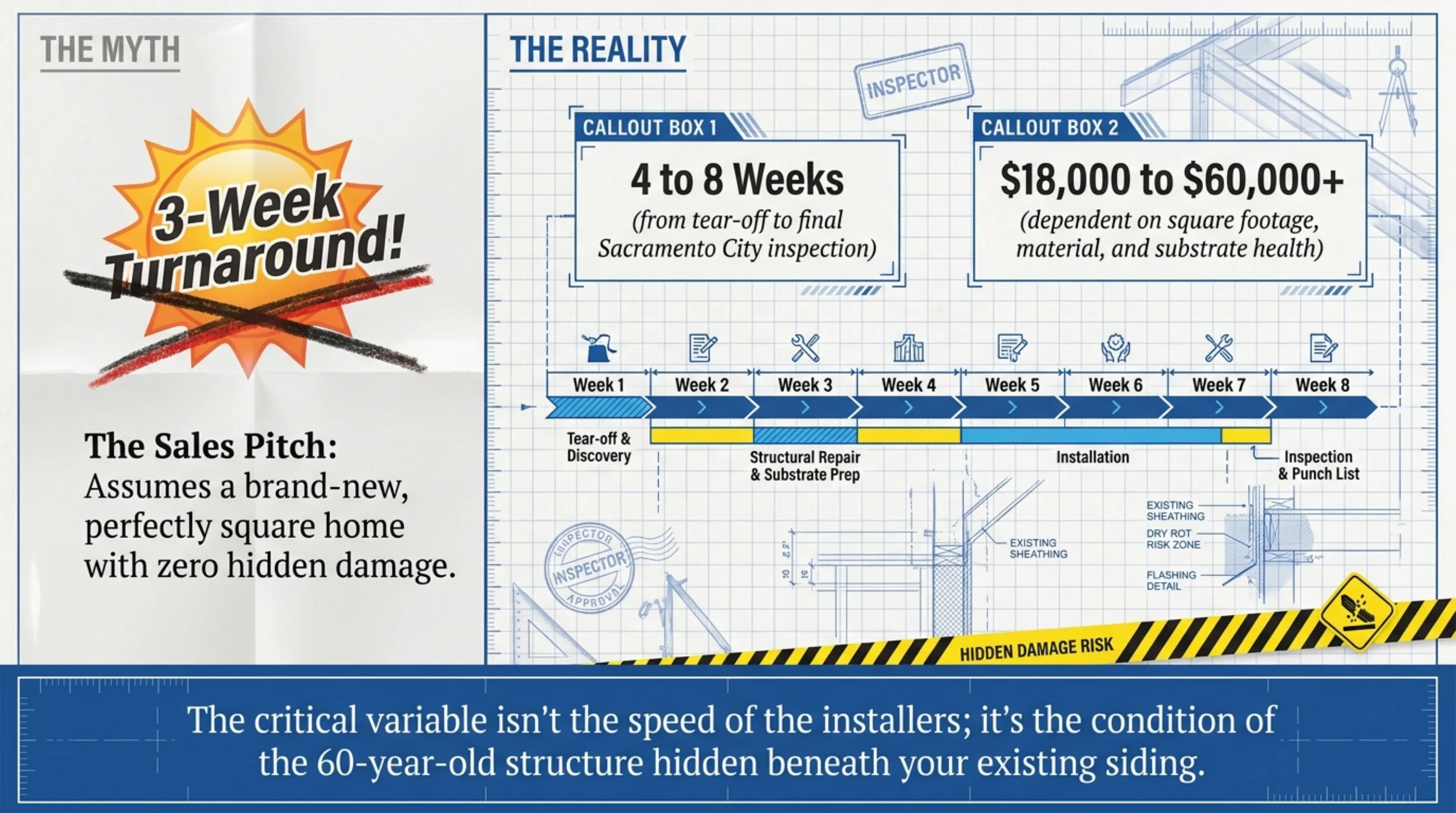

The marketing timeline for a siding job is three weeks. You see it in brochures and hear it from salespeople. That three weeks covers the installation phase on a brand-new, perfectly square house with no surprises. It’s not a lie, but it’s not the whole truth. The realistic timeline for your Sacramento home, from the day you sign the contract to the day you make the final payment, is closer to two months. The critical variable isn’t the speed of the installers; it’s the condition of the structure hidden beneath your existing siding. A house built in 1960 has sixty-plus years of history written on its sheathing, and that history often includes water. A great siding contractor sacramento anticipates this. They build time for potential repairs into their schedule and prepare you for the possibility. A lesser contractor is surprised by it, leading to delays and conflict. The honest timeline isn't a sales pitch; it's a mark of a professional who respects the job and your home.

Sources & Methodology

Renology reviews public permit and labor signals, supplier pricing, remodeler quote patterns, comparable projects, the Renology Cost Index, and the Renology Methodology. Cost references are planning ranges for Sacramento siding projects, not fixed bids.

This article is from The Renology Magazine, the renovation magazine and contractor-advisory for homeowners in Southern California, San Diego, and Greater Seattle. Want more renovation breakdowns? Search "The Renology Magazine" on Google.

Sources & methodology

How Renology builds this guide

Renology combines public permit and labor signals, supplier pricing, remodeler quote patterns, and editorial review of comparable projects. Cost references are planning ranges, not fixed bids, because site conditions, materials, access, permits, and finish level can change the final price.

  • Benchmarked against the Renology Cost Index, related service guides, and the Renology Methodology.
  • Reviewed for Sacramento market context when a local market is available.
  • Focused on siding scope, materials, timeline, contractor risk, and budget drivers.

Sacramento · pre-screened

Get 3 Sacramento siding bids in 48 hours.

Our editors already vetted Sacramento siding contractors. Answer 4 questions and we send 3 written bids inside 48 hours, with the real price for your scope, not their inflated first-call number.

  • Free, no commission
  • Pre-screened locally
  • Bids inside 48 hours
Send my 3 bids

Takes about 60 seconds. We'll text you when bids arrive.

Frequently Asked Questions

How long does a siding replacement in Sacramento really take?
For a typical single-family home in Sacramento, the on-site work for a full siding replacement takes between four and eight weeks. This range accounts for variables like the size of your home, the material you choose, and the extent of any necessary repairs to the underlying structure. A small, newer home with no issues might be done in three to four weeks. A larger, historic home in a neighborhood like Midtown or Land Park with significant dry rot could easily take eight to ten weeks. The timeline begins with demolition and repair, moves to installation of the new siding and trim, and finishes with painting, cleanup, and a final city inspection. The most unpredictable factor is the condition of the wall sheathing, which is unknown until the old siding comes off.
Can I live in the home during the siding replacement?
Yes, you can absolutely remain in your home during a siding project. All the work is contained to the exterior. However, you should be prepared for significant noise and disruption. The process involves power saws, nail guns, and generators, creating noise from early in the morning until the end of the workday. There will be a large dumpster in your driveway and building materials staged around the property. Your yard will be an active construction zone, so access may be limited, and you'll need to be mindful of debris. While the interior remains livable, the exterior environment will be chaotic. It's a trade-off: you save on hotel costs, but you live with the noise and mess for the duration of the project.
What's the longest single phase of a siding project?
By far, the longest and most unpredictable phase can be the substrate repair. If the demolition phase reveals extensive dry rot, termite damage, or other structural issues, all siding work stops. At that point, carpenters must be brought in to cut out and replace damaged sheathing, framing members, and potentially even window sills or headers. This can add anywhere from a few days to two weeks to the project, depending on the severity. If no significant repairs are needed, then the longest phase is typically the installation of the siding and trim itself, which can take one to three weeks depending on the home's size and complexity. The repair phase is the one that blows up schedules and budgets.
Can I fast-track the permits for siding in Sacramento?
In many cases, you can avoid the permit process altogether. The Sacramento Community Development Department does not typically require a permit for re-siding if you are replacing the existing material with the same type of material (e.g., vinyl for vinyl). However, if you are changing materials (e.g., wood to fiber cement) or if the project requires any structural repairs to the wall framing, a permit is mandatory. When a permit is required, there isn't really a 'fast track' option for this type of project. The good news is that siding permits are generally straightforward and don't face the same backlogs as a major addition or new construction. A competent, experienced siding contractor can work through the city's process efficiently, and it's rarely the primary cause of delay in a siding project.
What siding material is best for Sacramento's extreme heat?
For the intense summer heat and high UV exposure in Sacramento, fiber cement siding is the premium choice. Products like James Hardie are engineered to be dimensionally stable, meaning they don't expand and contract significantly with temperature changes. This prevents the warping, buckling, and gapping that can plague other materials. Its composition also makes it highly resistant to fading and damage from direct sun. A good secondary option is a high-quality, thick-gauge vinyl siding. Cheaper, thinner vinyl will deform in the heat, but premium panels are formulated for better thermal performance. Natural wood is a beautiful but high-maintenance option in Sacramento; it requires diligent sealing and painting to prevent it from drying, cracking, and splitting under the relentless sun.
How much does siding replacement cost in Sacramento in 2026?
The siding sacramento cost for a full replacement in 2026 can range widely, from about $18,000 to over $60,000. For a typical 1,800-square-foot home, a vinyl siding replacement might cost between $20,000 and $28,000. The same size house using James Hardie fiber cement siding would likely fall in the $30,000 to $45,000 range. The final price depends on several key factors: the square footage of your exterior walls, the type and quality of the siding material chosen, the architectural complexity of your home (more corners and windows means more labor), and, most importantly, the extent of any necessary substrate repairs. A project with extensive dry rot repair can easily add $5,000 to $15,000 to the total cost. Always get multiple detailed quotes.
Do I need to replace my windows when I replace my siding?
You don't have to, but it is the most logical and cost-effective time to do it. The proper way to install new windows is to flash them directly to the wall sheathing, and then install the new weather-resistive barrier and siding over the window's nailing fin. This creates a smooth, waterproof seal. If you replace siding first and then decide to do windows a few years later, the installers will have to cut back the new siding and trim to install the windows correctly, leading to a patched, less reliable result. Combining the projects saves significant labor costs and ensures the entire wall assembly, from window to siding, is integrated perfectly for maximum water and air protection. It's a classic case of 'do it right, do it once'.
What is a weather-resistive barrier (WRB) and why is it important?
A weather-resistive barrier, often known by the brand name Tyvek, is a special membrane that is wrapped around the exterior sheathing of your house before the siding is installed. Its job is critical: to act as a secondary drainage plane. Siding is the first line of defense against rain, but no siding system is perfectly waterproof. Wind-driven rain can get behind the boards. The WRB is the home's raincoat; it stops that water from reaching the wood sheathing and framing, directing it safely down and out. A failed, torn, or improperly installed WRB is the root cause of almost all major dry rot issues. During a re-siding project, installing a new, properly lapped and taped WRB is one of the most important steps for ensuring the long-term durability of your home.
