How a Kitchen Remodel in Portland Actually Goes: A Week-by-Week Timeline (2026)

A realistic week-by-week timeline for a Portland kitchen remodel, from design and permits to final inspection. Learn the four phases, major delay risks, and what a 2026 kitchen portland project actually costs.

Mike ReynoldsยทApril 2026ยทUpdated May 2026ยท8-min read

$48K-$115K

Mid-range 180 sq ft, 2026

10-18 weeks

Contract to final inspection

40%

Of total project budget

5-7 weeks

Bellevue DSD 2026

Reviewed by the Renology Editorial Team|Last updated: May 2026
๐ŸŽงRenology PodcastSubscribe โ†’

A full kitchen remodel in Portland takes between 18 and 26 weeks, from initial design to final inspection. The kitchen portland cost and timeline can start lower, around 10 to 14 weeks, for a cosmetic refresh in a Pearl District condo with no layout changes. But for a gut job in an older Laurelhurst home, plan for six months. The biggest single delay we see in Portland kitchens is discovering unreinforced masonry or inadequate seismic strapping once the walls are open. What looks like a simple cabinet swap can quickly turn into a structural project. It happens every time.

In a Nutshell

  • Total Timeline: 18, 26 weeks for a full remodel.
  • Four Key Phases: Design & Permits; Site Prep & Demo; Framing & Rough-In; Finishes & Final Inspection.
  • Biggest Delay Risk: Unforeseen structural or seismic issues in pre-1980s homes.
  • Contingency Fund: The National Association of Home Builders recommends a ten to fifteen percent contingency on renovations in homes over thirty years old. This is not optional in Portland.

Phase 1: Design and Permits (Weeks 1, 8)

3 Portland kitchen remodelers, editor-screened. 4 questions.

See my 3 matches

This is where the project is won or lost. You don't build a kitchen with a hammer, you build it with a set of plans. This phase is about locking down every single decision before a tool belt is buckled.

  • What Happens: Your designer or architect draws up the plans. A structural engineer signs off on any load-bearing wall changes. You select and order every finish: cabinets, countertops, flooring, tile, lighting, and appliances. This is your scope-lock date. After this, changes cost double.
  • Who's Involved: The homeowner, an architect or kitchen designer, and your general contractor. The contractor should be involved now to give feedback on buildability and cost.
  • Common Holdups: Homeowner indecision is the main culprit. The second is waiting for an engineering review. Your plans are then submitted to Portland's Bureau of Development Services (BDS) for review. A complete, professional submission is the only way to avoid months in limbo.

Phase 2: Site Prep and Demolition (Weeks 9, 11)

The first two weeks of noise and dust feel like progress. They're actually about discovery. Demolition is an archeological dig into your home's past sins.

  • What Happens: We set up dust barriers and protect adjacent rooms. The old kitchen is torn out down to the studs. This is where we find the rot under the sink, the ungrounded knob-and-tube wiring, or the floor joists someone cut through a century ago. Any required structural or seismic upgrades happen now.
  • Who's Involved: The demolition crew and your general contractor. Sometimes a specialized trade like an asbestos abatement team is needed.
  • Common Holdups: Finding hazardous materials stops work cold. Uncovering major structural flaws means a call to the engineer and a permit revision with the BDS. Utility lines, managed by entities like Pacific Power and the Portland Water Bureau, may need relocation, which wasn't in the original scope.

Phase 3: Framing and Rough-In (Weeks 12, 15)

This phase is about the bones. It's the work behind the walls that ensures your kitchen functions safely for the next fifty years. Nothing flashy happens here, but it's the most critical part of the build.

  • What Happens: New walls are framed. The plumber runs new supply and drain lines. The electrician pulls new circuits for appliances and lighting. The HVAC tech moves or adds vents. Each trade does its work in a specific sequence.
  • Who's Involved: Framers, plumbers, electricians, and HVAC technicians. The city inspector is the most important person on site this month.
  • Common Holdups: The inspection card is the scorecard. A failed rough-in inspection for plumbing or electrical can cause a week of delay while work is corrected and a re-inspection is scheduled. The trades must work in sequence. One no-show can push the whole schedule back.

Phase 4: Finishes and Final Inspection (Weeks 16, 22)

This is where the space starts looking like a kitchen again. It's also a parade of different trades that have to work around each other in a tight space. Coordination is everything.

  • What Happens: Insulation goes in, then drywall is hung, taped, and textured. The room gets primed and painted. Then flooring is installed, followed by cabinets. The countertop fabricator templates, and installs a week or two later. Backsplash tile, light fixtures, plumbing fixtures, and appliances are the final pieces.
  • Who's Involved: Drywallers, painters, flooring installers, cabinet makers, countertop fabricators, tile setters, electricians, and plumbers.
  • Common Holdups: Long lead times. Custom cabinets can take 12 weeks. Some appliances are still facing supply chain issues. A countertop slab can arrive cracked. One delayed trade creates a domino effect for everyone else.

Three Representative Projects from 2026

Three representative projects from 2026, scoped similarly, reconstructed from Renology's Project of the Day network and used here in aggregate form:

A kitchen contractor and homeowner in Portland review cabinet samples during a remodel.
  • Laurelhurst 1925 Colonial: A 280 sq. ft. full gut remodel. Required moving a load-bearing wall and seismic upgrades. High-end custom cabinets and appliances. Total cost: $185,000. Total time: 25 weeks.
  • Pearl District Condo: A 150 sq. ft. cosmetic update. Refaced cabinets, new quartz countertops, tile, and appliances within the existing layout. No permits required. Total cost: $75,000. Total time: 12 weeks.
  • Sellwood-Moreland 1950s Bungalow: A 200 sq. ft. remodel. Removed a non-load-bearing wall to open the space to the dining room. Semi-custom cabinets and mid-range appliances. Total cost: $110,000. Total time: 20 weeks.

What Can Compress This Timeline

The homeowner who saves six weeks does three things before signing a contract. First, they finalize every single material selection and sign off on a scope-lock date. No changes. Second, they order their long-lead-time items, like custom cabinets and windows, months in advance. These items should be in a local warehouse before demo starts. Third, they hire a professional kitchen contractor in Portland with a dedicated project manager. An organized contractor who can schedule subs tightly is worth every penny. Your ability to make decisions early is the single greatest variable you control.

What Blows It Up

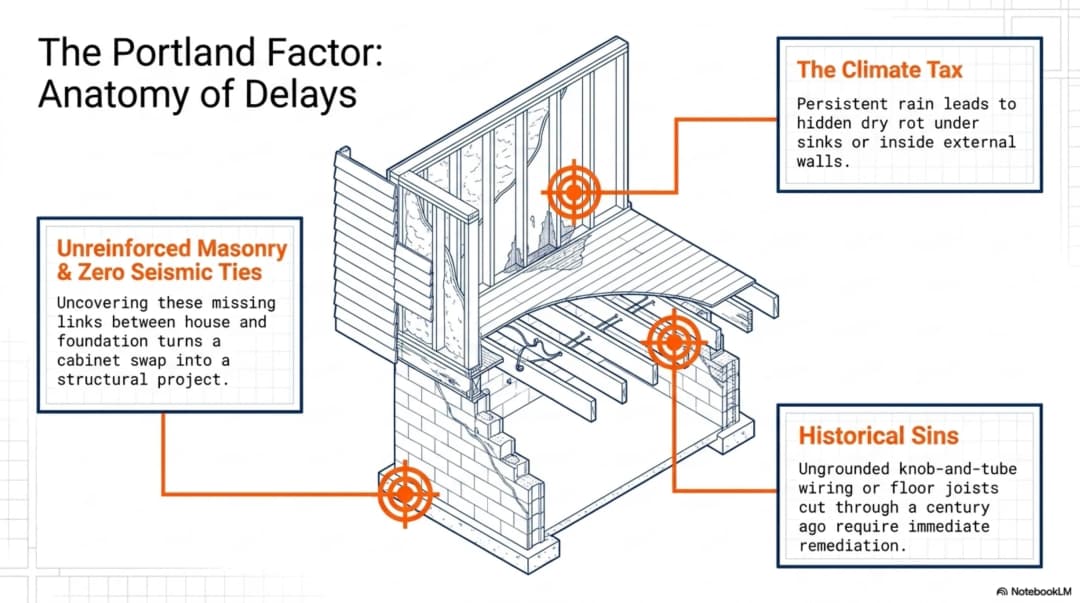

Three things kill a kitchen remodel timeline. First is scope creep. Adding a 'small change' mid-project is never small. It requires new drawings, new orders, and rescheduling trades. Second is uncovering unforeseen conditions. In Portland kitchens, this is often dry rot from persistent rain or discovering the house has zero seismic ties to the foundation. Third is a dispute with your contractor. Vetting your kitchen contractor Portland is the most important decision you'll make. The National Association of Home Builders recommends a ten to fifteen percent contingency on renovations in homes over thirty years old. Use it for surprises, not for changing your mind on the backsplash.

What Should Be in Your Contractor's Schedule

Your contractor's schedule shouldn't be a vague promise. It should be a document with dates. Demand to see these line items before you sign:

  1. Final Design & Selections Lock Date
  2. Permit Submission Date
  3. Anticipated Permit Issuance Date
  4. Long-Lead Material Order Dates (Cabinets, Windows, Appliances)
  5. Project Start / Demolition Date
  6. Rough-In Inspection Dates (Framing, Plumbing, Electrical)
  7. Cabinet Delivery & Installation Start Date
  8. Countertop Template & Installation Dates
  9. Final Inspection Date
  10. Project Completion & Punch List

A detailed schedule shows you have a professional, not a handyman. For more on the paperwork, see our permit playbook.

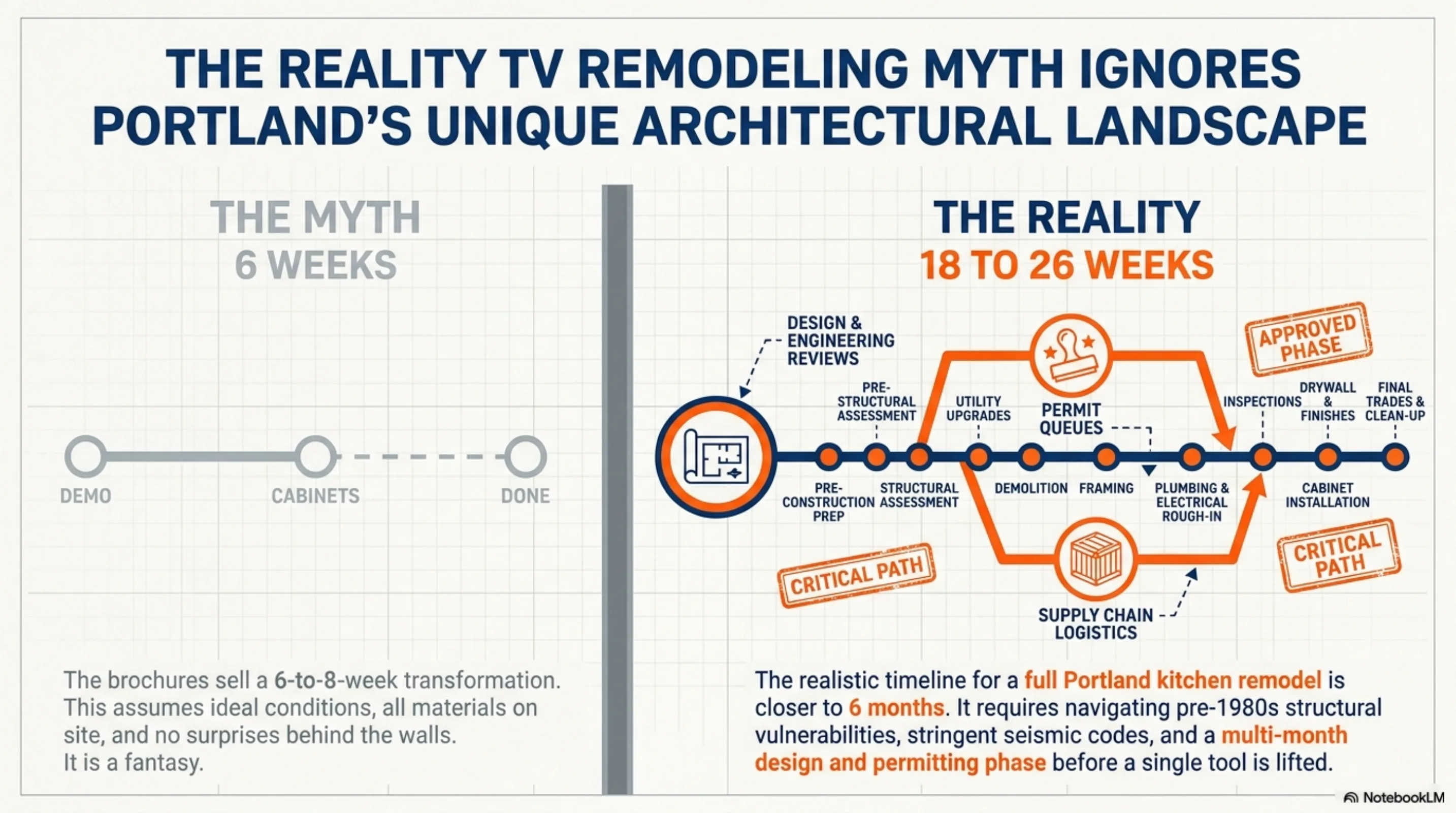

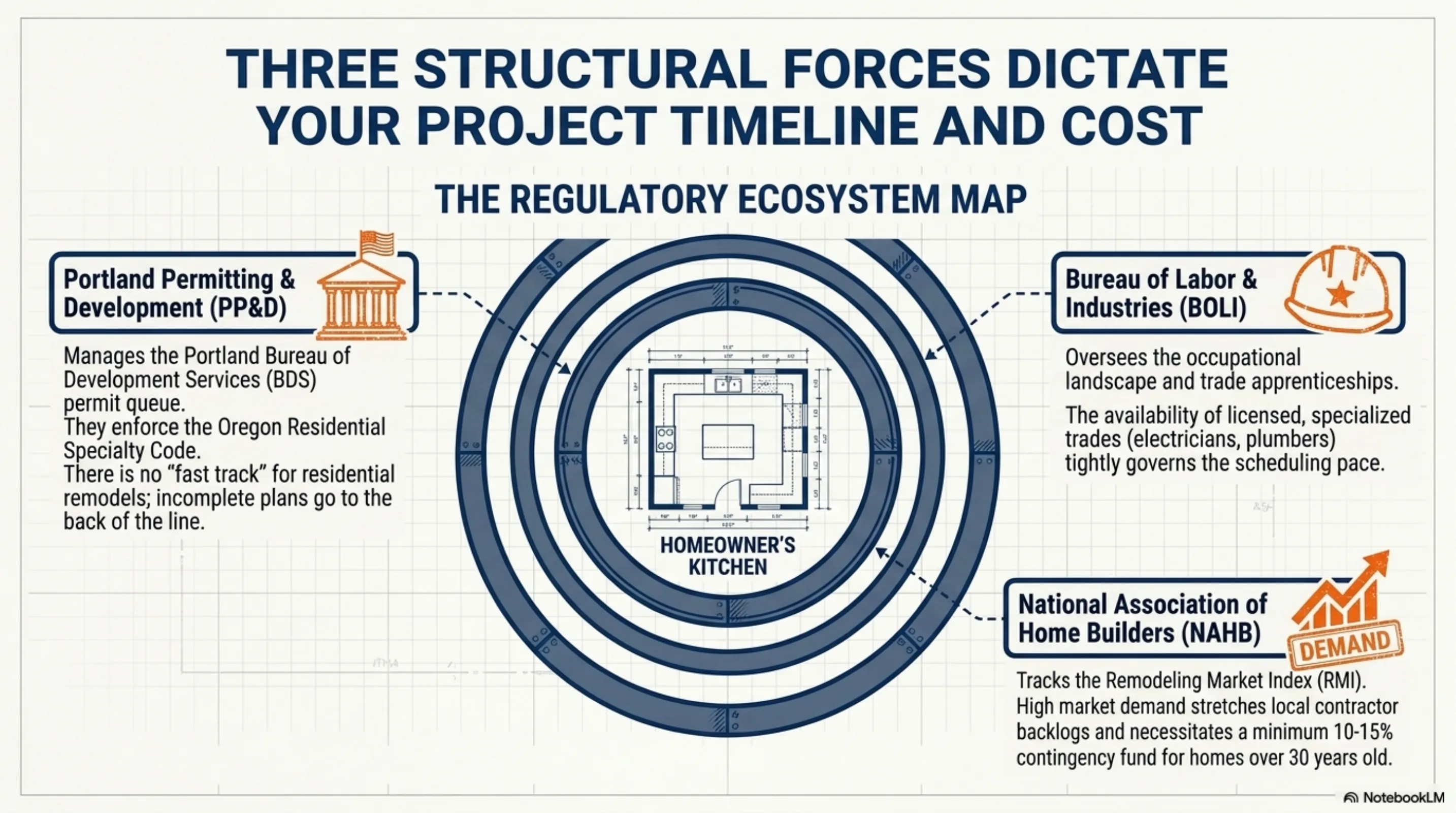

Visual breakdown

Renology Take

The brochures for Portland kitchens sell a six to eight week transformation. That's the construction timeline, under ideal conditions, with all materials on site and no surprises behind the walls. It's a fantasy. The realistic timeline for a significant kitchen portland remodel is closer to six months when you include the critical design and permitting phase. A fast project is often a poorly planned one. The real job of a great contractor isn't just managing subs, it's anticipating the problems unique to Portland's housing stock, from its wet climate to its seismic vulnerabilities. Rushing the planning phase to get to demo faster is the most common and costly mistake a homeowner can make. Good kitchens are built on paper first.

Sources

Get 3 Portland kitchen bids in 48 hours.

Our editors already screened Portland kitchen remodelers. Answer 4 questions; we send 3 written bids inside 48 hours, with the real price for your scope, not their inflated first-call number.

Send my 3 bids

Free. No commission. If a match doesn't fit, we'll send another.

Frequently Asked Questions

How long does a kitchen remodel in Portland really take?
For a complete gut remodel, plan for 18 to 26 weeks from the start of design to the final inspection. This includes 6-8 weeks for design, engineering, and permitting with the Portland Bureau of Development Services. The construction itself typically takes 12-18 weeks. Smaller, cosmetic-only projects in condos without layout changes can be faster, around 10-14 weeks. The timeline for kitchen portland 2026 projects is heavily influenced by material lead times and the age of your home, as older houses often hide structural or seismic issues that need addressing.
Can I live in the home during construction?
You can, but it's tough. Expect constant dust, noise from 8 AM to 5 PM, and a parade of tradespeople in your space. You'll be without a functioning kitchen for at least three months. This means setting up a temporary kitchen with a microwave, toaster oven, and mini-fridge in another room and washing dishes in a bathroom sink. For families with young children or pets, or for those who work from home, the disruption is significant. Many clients choose to stay elsewhere during the most intense phases, like demolition and drywall.
What's the longest single phase?
It's a tie between two phases. Phase one, "Design and Permits," can easily take 8-10 weeks or more. This is because it involves not just your decisions but also waiting on architects, engineers, and the city's permit review queue. During construction, Phase four, "Finishes," is often the longest. It can stretch for 6-8 weeks or more due to the sheer number of sequential steps and trades involved, from drywall and painting to flooring, cabinets, countertops, and final fixture installation. A delay in any one of these can halt progress completely.
Can I fast-track the permits in Portland?
There is no official "fast track" option for most residential kitchen remodels at the Portland Bureau of Development Services (BDS). The speed of your permit issuance depends almost entirely on the quality and completeness of your application. The fastest way through the system is to hire an experienced architect or designer who knows Portland's codes and submits a perfect, unambiguous set of plans. Incomplete drawings or plans that don't meet Oregon Residential Specialty Code will get sent to the back of the line with corrections requested, adding weeks or even months to your wait.
