A modern, newly remodeled bathroom in a San Francisco home, featuring a walk-in shower with glass doors, a floating vanity, and clean tile work.

Process

How a Bathroom Remodel in San Francisco Actually Goes: A Week-by-Week Timeline (2026)

A full gut bathroom remodel in San Francisco takes 12-20 weeks, including permits. We break down the four phases, from design and SFDBI review to final inspection.

Mike Reynolds·April 2026·Updated May 2026·8-min read

$48K-$115K

Mid-range 180 sq ft, 2026

10-18 weeks

Contract to final inspection

40%

Of total project budget

5-7 weeks

Bellevue DSD 2026

Reviewed by the Renology Editorial Team|Last updated: May 2026
🎧Renology PodcastSubscribe →

A full gut bathroom remodel in San Francisco takes 12 to 20 weeks, start to finish. I'm talking permits, demo, and final polish. Timelines can start lower, around six to eight weeks, for a cosmetic refresh in a modern SoMa condo with no layout changes. But for most pre-war homes in neighborhoods like Noe Valley, the biggest delay isn't materials or labor. It's the San Francisco Department of Building Inspection (SFDBI) plan review process, especially if your building has a whiff of historic character. Assume the city will take its time. Plan for it. A proper bathroom san francisco remodel is a marathon, not a sprint.

In a Nutshell

  • Total Timeline: 12, 20 weeks for a full, permitted remodel.
  • Key Phases: Design & Permits; Demolition & Abatement; Rough-In & Inspection; Finishes & Final.
  • Biggest Delay Risk: Permit review cycles at SFDBI, and discovering structural rot or knob-and-tube wiring behind walls.
  • Contingency Fund: The National Association of Home Builders recommends a ten to fifteen percent contingency fund. In San Francisco's older homes, I tell clients to budget a firm twenty percent.

Phase 1: Design and Permits (Weeks 1, 6)

3 San Francisco bathroom remodelers, editor-screened. 4 questions.

See my 3 matches

This is the paper phase. Nothing happens on site, but the entire project is decided here. Your architect or designer draws up the plans, ensuring they comply with California's Title 24 energy code and local seismic standards. You, the owner, select every fixture, tile, and finish. This is when your scope-lock date is set; it's the point of no return for changes. A good bathroom contractor in San Francisco will have a permit expediter who knows the SFDBI system inside and out. Common holdups include incomplete submittals getting kicked back by the city or plans for older buildings triggering a historic preservation review. If you're moving a load-bearing wall, expect to add weeks for structural engineering before you can even submit. This phase ends when the permit is in hand.

Phase 2: Site Prep and Demolition (Weeks 7, 8)

Work begins. The contractor's crew installs dust barriers and floor protection to contain the mess. Then, demolition starts. For any home built before 1978, this phase must include testing for lead paint and asbestos by a certified abatement specialist. This isn't optional; it's California law. The biggest risk here is the unknown. Once the walls are open, we might find corroded galvanized supply lines, active knob-and-tube remnants, or dry rot in the floor joists from a slow leak. Discoveries like that stop the job cold. It means a revised plan, a change order, and possibly a trip back to the city for a permit revision. Utility shutoffs are carefully coordinated with PG&E and the San Francisco Public Utilities Commission (SFPUC).

Phase 3: Framing and Rough-In (Weeks 9, 11)

With the room stripped to the studs, the rebuild starts. Carpenters re-frame walls and build out any new structures like shower niches or pony walls. Then the trades arrive in a specific sequence. Plumbing goes first, laying new supply and drain lines. Electrical is next, running new circuits for lights, outlets, and the fan. Finally, mechanical for the ventilation ducting. Each trade's work must be inspected and signed off by a city inspector before anything can be covered up. The inspection card posted on site tells the story. A passed rough-in inspection means the bones of the project are sound and the load path is correct. You cannot proceed to drywall until you have those signatures. This is a critical checkpoint for all san francisco bathrooms.

Phase 4: Finishes and Final Inspection (Weeks 12, 16)

After the rough-in inspections are cleared, the walls get closed. This involves insulation, vapor barriers, and moisture-resistant drywall. In the wet areas, waterproofing is everything. A full membrane system like Schluter-KERDI is the standard for a job built to last. Then comes the visible progress: tile installation, grouting, painting, and setting the vanity and toilet. Electricians return to install lights and switches, and the plumber sets the faucets and shower trim. The final step is the final inspection from SFDBI. The inspector verifies GFCI protection, ventilation rates, and fixture operation. A passing grade gets you a Certificate of Final Completion. The project is officially done. This is the moment every homeowner and bathroom contractor in San Francisco works toward.

Three Representative Projects from 2026

Three representative projects from 2026, scoped similarly, reconstructed from Renology's Project of the Day network and used here in aggregate form:

A homeowner and their contractor review tile samples in a partially demolished bathroom space.
  • Pacific Heights Master Bath: A full gut and expansion in a 1920s Edwardian. 180 sq ft. Relocated all fixtures, added a steam shower, and installed a custom floating vanity. Required structural engineering and extensive historic review. Total cost: $115,000. Total timeline: 22 weeks.
  • Sunset District Guest Bath: Mid-range gut remodel in a 1950s row house. 60 sq ft. Kept the existing layout, replacing all fixtures, tile, and vanity. Dealt with corroded galvanized supply lines found during demo. The total bathroom san francisco cost came to $48,000. Total timeline: 14 weeks.
  • SoMa Condo Powder Room: A cosmetic refresh in a modern high-rise. 30 sq ft. New vanity, toilet, faucet, lighting, and paint. No permits were required as the footprint was unchanged. Total cost: $15,000. Total timeline: 4 weeks (two of which were waiting for the vanity to arrive).

What Can Compress This Timeline

The homeowner who saves six weeks does three things before signing. First, they lock the scope. Every change order after demolition starts is a two-week delay, minimum. Don't decide on tile after the walls are open. Decide on it before the permit is even filed. Second, they order every single finish material, from the tub to the towel bars, and have it sitting in the garage before the first hammer swings. Supply chain delays are real; don't let a backordered faucet hold up your entire project. Third, they hire a design-build firm. One contract, one point of responsibility. The architect and builder are on the same team from day one, not pointing fingers when a problem arises.

What Blows It Up

Three things kill a San Francisco bathroom remodel schedule. One: surprises in the walls. Unreinforced masonry, active knob-and-tube wiring, or major pest damage means a full stop for engineering and revised permits. This is common in the city's beautiful but old housing stock. Two: Historic Preservation review. If your building is a landmark or in a conservation district, the city gets a say on everything, adding months of review. Three: Neighbors. In a condo or attached home, access issues, HOA approvals, and noise complaints can cause serious delays. The National Association of Home Builders recommends a ten to fifteen percent contingency on renovations in homes over thirty years old. In San Francisco, I advise my clients to make it twenty percent.

What Should Be in Your Contractor's Schedule

A real schedule isn't a guess. It's a document that outlines the critical path. Demand these line items from any bathroom contractor you're considering. It shows they've thought through the logistics of building in a tough city.

  1. Scope-lock date
  2. Permit submission date
  3. Permit issuance date (target)
  4. Material order deadlines and expected delivery dates
  5. Demolition start date
  6. Rough plumbing inspection date
  7. Rough electrical inspection date
  8. Close-wall date (post-inspection)
  9. Tile start date
  10. Final inspection date (target)

For a deeper dive on the city process and what to expect from the paperwork, see our [permit playbook](/guides/san-francisco-bathrooms-permit-playbook-2026).

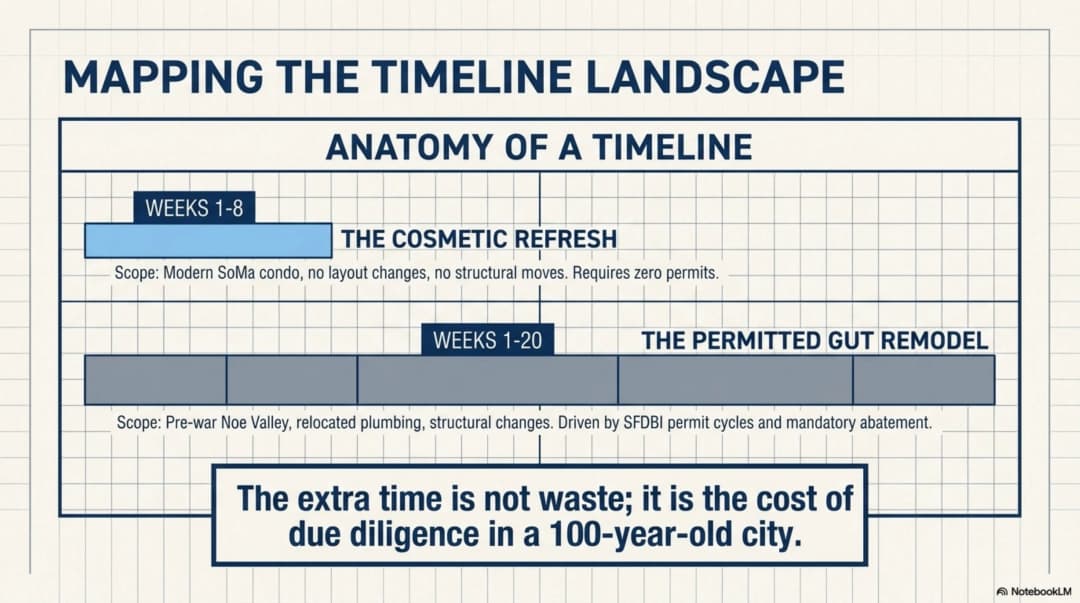

Visual breakdown

Renology Take

The internet is full of "six-week bathroom remodel" stories. Those aren't happening in San Francisco, not for a real remodel. That marketing timeline ignores the six weeks of design and permitting upfront. It assumes you have a new-build home with perfect framing and no surprises. The reality for most san francisco bathrooms is a four-month project. The extra time isn't waste; it's the cost of due diligence. It's for navigating a tough permit office, for properly abating hazards in a 100-year-old home, and for building something that will pass inspection and last another fifty years. Don't rush the parts that matter. A solid foundation, a correct rough-in, and perfect waterproofing are what separate a good job from a disaster waiting to happen.

Sources

Get 3 San Francisco bathroom bids in 48 hours.

Our editors already screened San Francisco bathroom remodelers. Answer 4 questions; we send 3 written bids inside 48 hours, with the real price for your scope, not their inflated first-call number.

Send my 3 bids

Free. No commission. If a match doesn't fit, we'll send another.

Frequently Asked Questions

How long does a bathroom remodel in San Francisco really take?
For a full gut remodel requiring permits, plan for 12 to 20 weeks from the day you sign with a contractor to the final inspection. This includes four to six weeks for design and permitting before any work begins. Simple cosmetic updates without moving plumbing or walls can be done in four to eight weeks. The biggest variables for any bathroom remodel in San Francisco are the permit review time at SFDBI and the potential for discovering structural or plumbing issues in the city's older housing stock. Projects in historic buildings or those requiring significant structural changes will always trend toward the longer end of that timeline.
Can I live in the home during construction?
If you have a second full bathroom, yes. It's disruptive, but possible. The contractor should install plastic dust barriers and use air scrubbers to manage dust. Expect noise from 8 AM to 5 PM on weekdays. If it's your only bathroom, you cannot stay. Relocating fixtures means your water will be shut off for extended periods during the rough-in phase. For a primary bathroom remodel lasting three to four months, you need to arrange for an alternative place to live, or at least have a plan for showering and daily routines elsewhere. It's a key part of the bathroom san francisco 2026 planning process.
What's the longest single phase in a San Francisco bathroom remodel?
Phase one: Design and Permits. It often takes longer than the actual construction. A simple over-the-counter permit might be quick, but any project that involves moving walls, changing window sizes, or is located in a building with historic significance requires a full plan review by the San Francisco Department of Building Inspection. This process can easily take six to ten weeks, sometimes longer if corrections are required. This is also the phase where long-lead-time items like custom vanities or imported tile are ordered, adding to the "waiting" period before physical work can even start. It’s the hidden chunk of every timeline.
Can I fast-track the permits in San Francisco?
To a limited degree. San Francisco offers Over-the-Counter (OTC) permits for simple, in-kind replacement projects that don't alter the structure. This is the fastest route. For more complex projects, you can't truly "fast-track" the standard plan review. However, you can prevent delays. The best way is to hire an architect or designer and a contractor who have extensive experience with the SFDBI. They will submit a complete and code-compliant package from the start, minimizing the chances of it being kicked back for corrections, which is the most common cause of permit delays. A clean submission is the fastest submission.
